An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. JWST-PRES-012922 NIRSpec Status JWST Partners‘ Workshop Ottawa, May 18th 2009 ESA Project Manager: Peter Jensen ESA Project Scientist: Peter Jakobsen Prime Contractor Project Manager: Ralf Maurer Prime Contractor: Astrium GmbH Ralf Maurer, Harald Feuer Astrium GmbH Phone: +49 89 607-29469 Ralf.Maurer@astrium.eads.net

  2. Status of Instrument Activities • Subcontractor Status • Programmatic Status and Looking 6 month ahead This document is the property of Astrium. It shall not be communicated to third parties without prior written agreement. Its content shall not be disclosed.

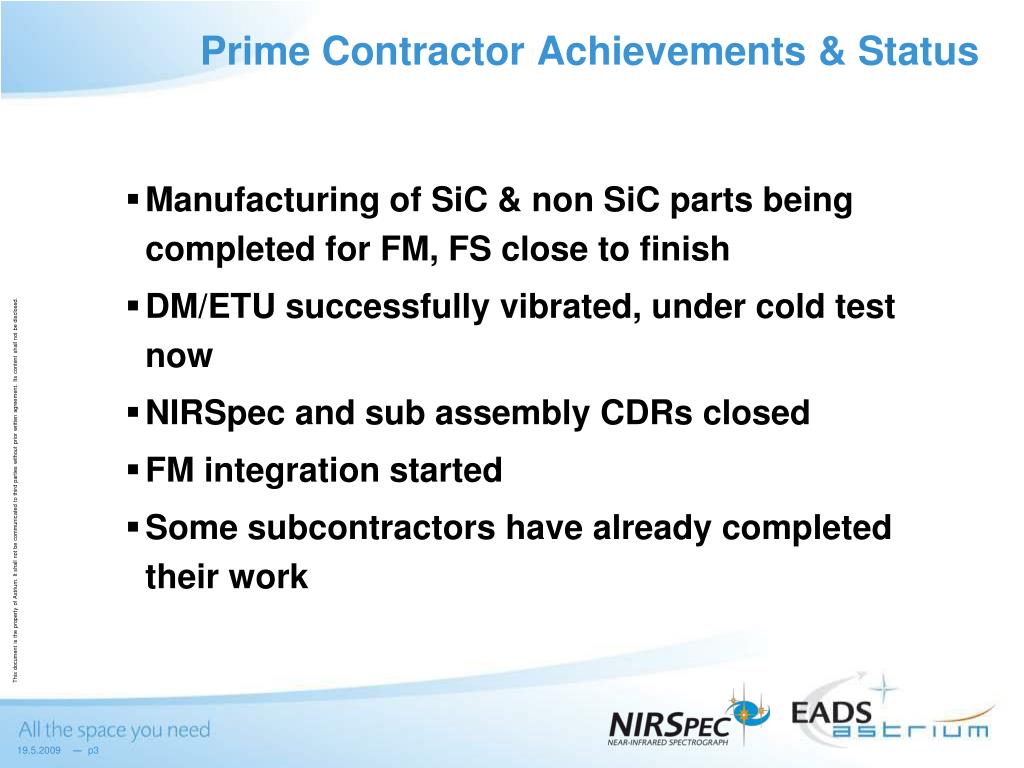

  3. Prime Contractor Achievements & Status • Manufacturing of SiC & non SiC parts being completed for FM, FS close to finish • DM/ETU successfully vibrated, under cold test now • NIRSpec and sub assembly CDRs closed • FM integration started • Some subcontractors have already completed their work

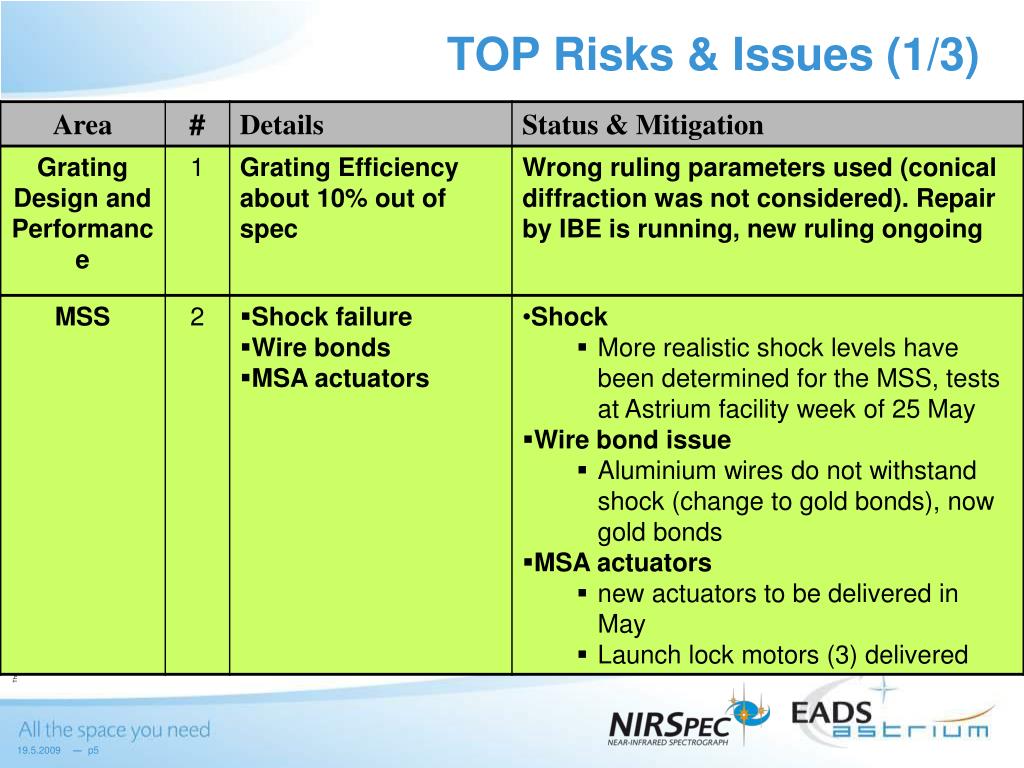

  4. TOP Risks & Issues (1/3)

  5. TOP Risks & Issues (2/3)

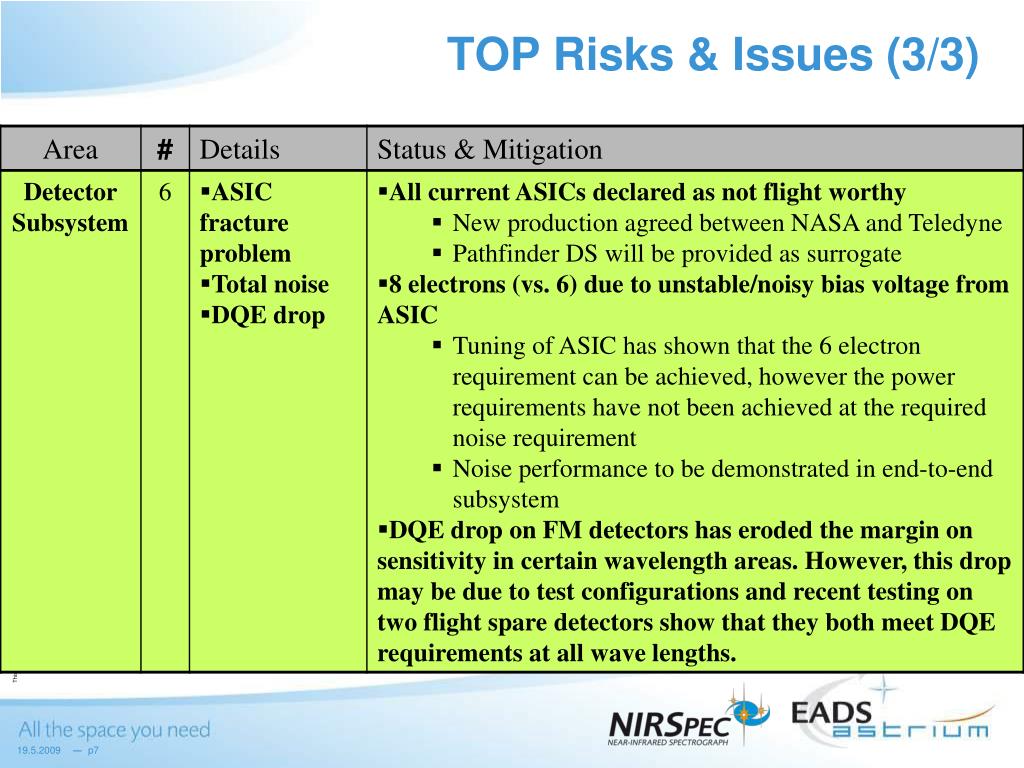

  6. TOP Risks & Issues (3/3)

  7. Status of Instrument Activities • Subcontractor Status • Programmatic Status and Looking 6 month ahead This document is the property of Astrium. It shall not be communicated to third parties without prior written agreement. Its content shall not be disclosed.

  8. Optical Bench Base Plate Part 1 COM housing CAM structure SiC Parts Achievements • Last piece under manufacturing Next Steps • Completion of manufacturing in July

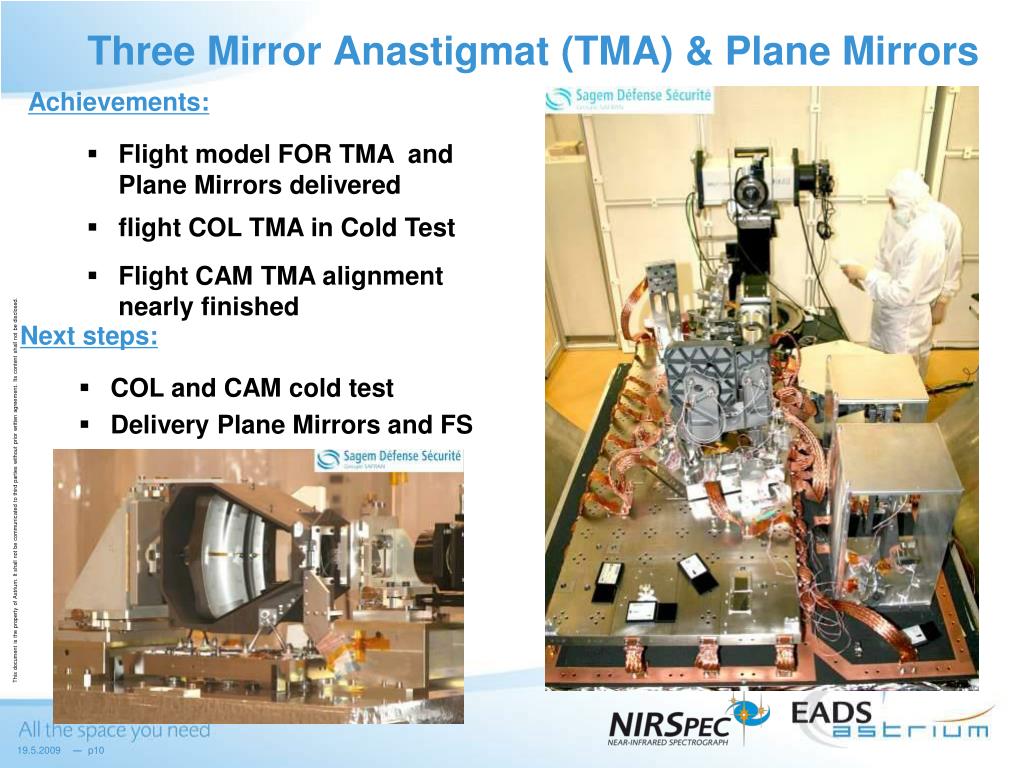

  9. Three Mirror Anastigmat (TMA) & Plane Mirrors Achievements: • Flight model FOR TMA and Plane Mirrors delivered • flight COL TMA in Cold Test • Flight CAM TMA alignment nearly finished Next steps: • COL and CAM cold test • Delivery Plane Mirrors and FS

  10. Grating and Filter Wheel Assembly (FWA) Achievements: • FWA FM in final integration step • GWA FM integration started • CDR closed, however FM grating manufacturing delayed Next steps: • FWA testing, delivery expected July • Grating manufacturing and GWA integration

  11. Refocus Mechanism Assembly (RMA) Achievements: • Intermediate FM delivered • New FM mirrors manufactured, one cold tested • New actuator development started Next steps: • FM/FS mirror coating to be completed • Actuator qualification • FM RMA integration and testing with new hardware

  12. IFU EQM alignment set-up Machined Slits (cropped) Integral Field Unit (IFU) Achievements: • IFU AQM pre shipment review in preparation • FM nearing completion and ready for testing end of May Next steps: • Completion of FM testing and delivery

  13. CAlibration Assembly (CAA) Achievements: • AQM under test • FM parts available Next steps: • AQM testing • Completion of FM integration, testing & delivery

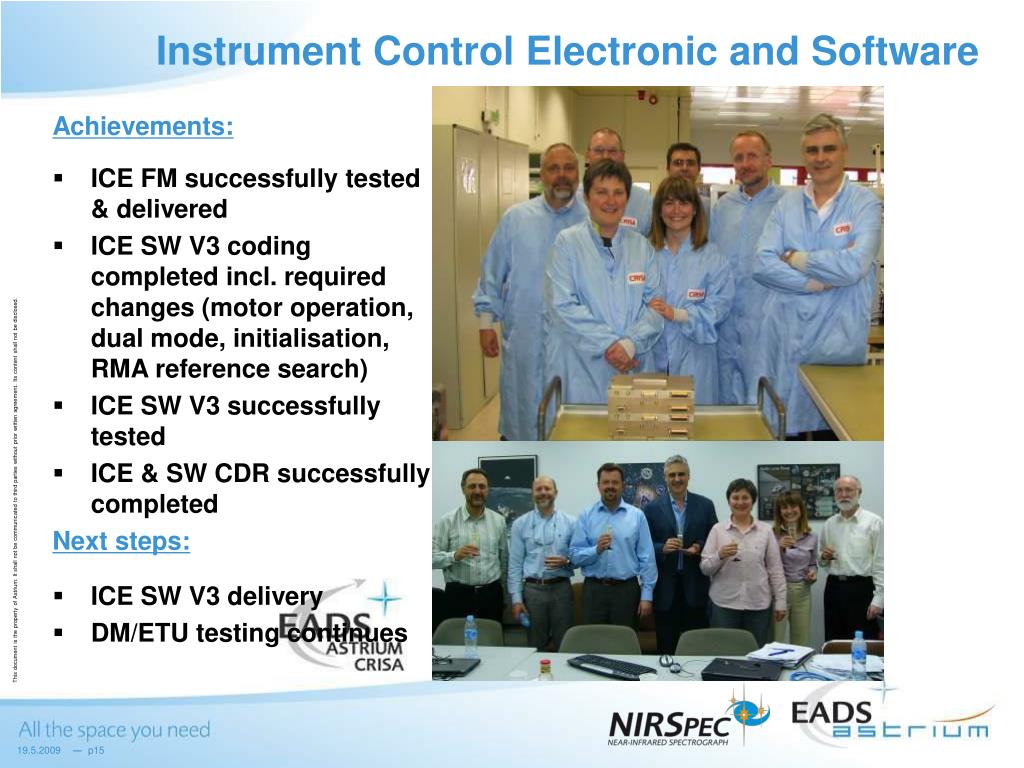

  14. Instrument Control Electronic and Software Achievements: • ICE FM successfully tested & delivered • ICE SW V3 coding completed incl. required changes (motor operation, dual mode, initialisation, RMA reference search) • ICE SW V3 successfully tested • ICE & SW CDR successfully completed Next steps: • ICE SW V3 delivery • DM/ETU testing continues

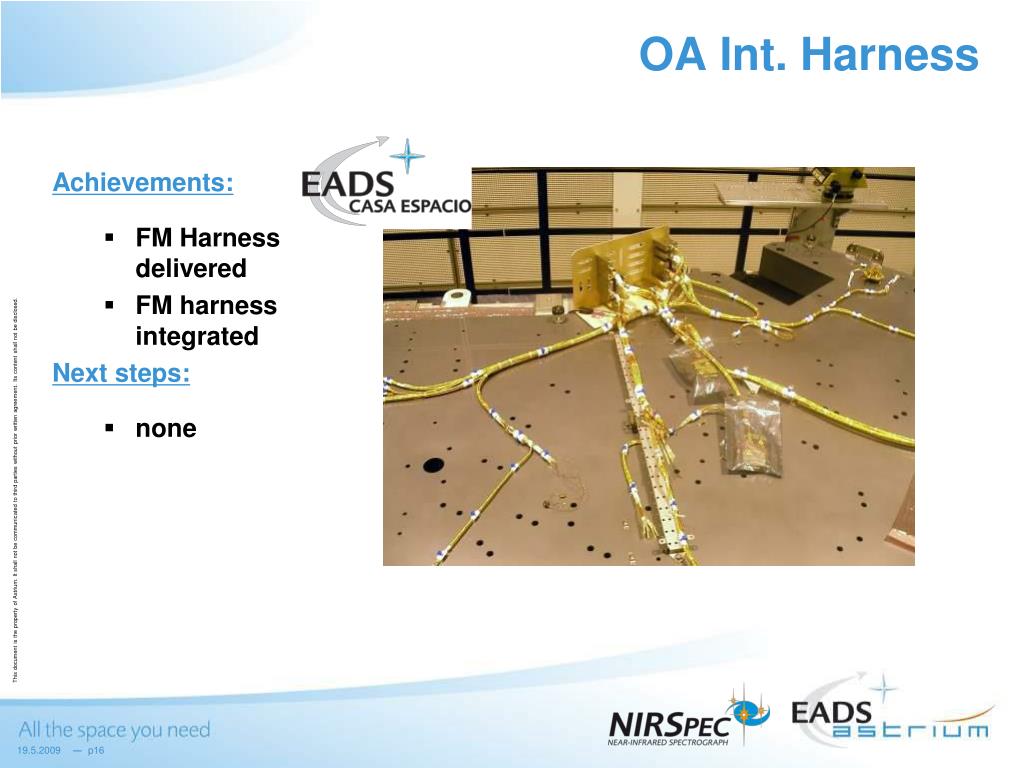

  15. OA Int. Harness Achievements: • FM Harness delivered • FM harness integrated Next steps: • none

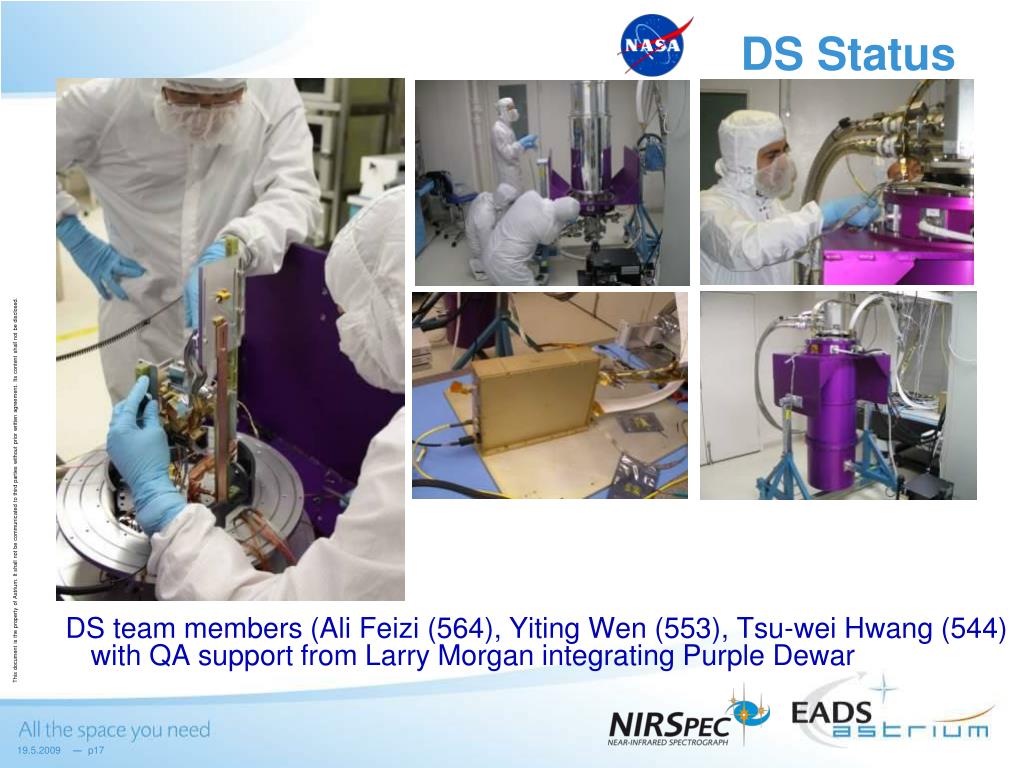

  16. DS Status DS team members (Ali Feizi (564), Yiting Wen (553), Tsu-wei Hwang (544) with QA support from Larry Morgan integrating Purple Dewar

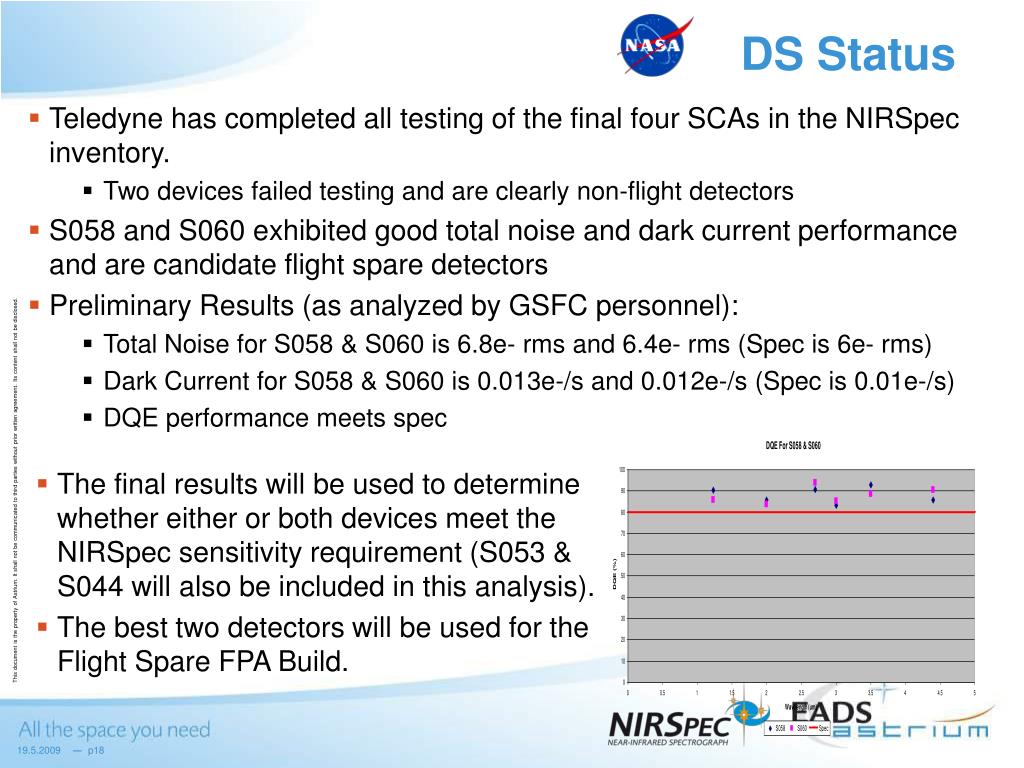

  17. DS Status • Teledyne has completed all testing of the final four SCAs in the NIRSpec inventory. • Two devices failed testing and are clearly non-flight detectors • S058 and S060 exhibited good total noise and dark current performance and are candidate flight spare detectors • Preliminary Results (as analyzed by GSFC personnel): • Total Noise for S058 & S060 is 6.8e- rms and 6.4e- rms (Spec is 6e- rms) • Dark Current for S058 & S060 is 0.013e-/s and 0.012e-/s (Spec is 0.01e-/s) • DQE performance meets spec • The final results will be used to determine whether either or both devices meet the NIRSpec sensitivity requirement (S053 & S044 will also be included in this analysis). • The best two detectors will be used for the Flight Spare FPA Build.

  18. DS Status • FPE to ASIC communication issues • Teledyne has determined that the issue can be solved by raising the common mode voltage to the ASIC • Working to change the common mode voltage (from 1.1 V to 1.8 V) supplied to the ASIC by the FPE • Meeting system noise/power requirements • The Detector Subsystem has not met both noise and power requirements during testing on the ETU and Pathfinder systems. • Noise requirements (<6e-) have been met, but at increased power dissipation from the ASIC. The ASICs being used on the Pathfinder Detector Subsystem have power dissipations of 14-17mW versus a requirement of 10.5mW

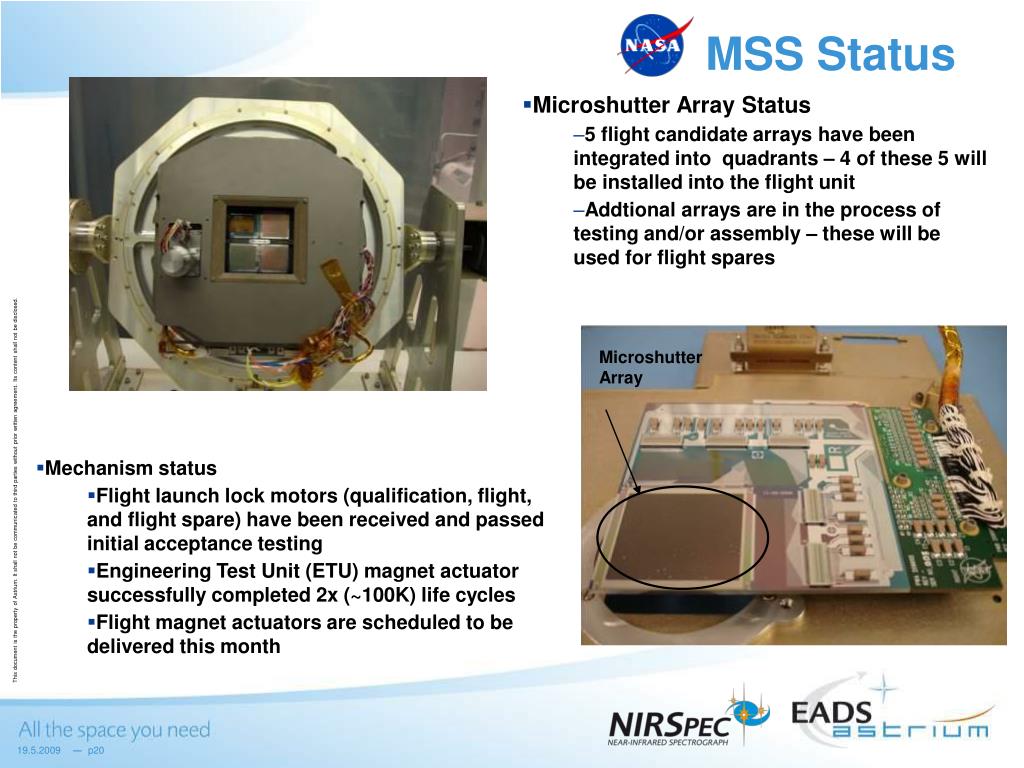

  19. MSS Status • Microshutter Array Status • 5 flight candidate arrays have been integrated into quadrants – 4 of these 5 will be installed into the flight unit • Addtional arrays are in the process of testing and/or assembly – these will be used for flight spares Microshutter Array • Mechanism status • Flight launch lock motors (qualification, flight, and flight spare) have been received and passed initial acceptance testing • Engineering Test Unit (ETU) magnet actuator successfully completed 2x (~100K) life cycles • Flight magnet actuators are scheduled to be delivered this month

  20. MSS Status • “Test Bed” Microshutter Control Electronics (MCE) • In final assembly and testing • Flight Microshutter Control Electronics (MCE) • Motor, Digital, and Analog Control Card (MDACC) is in assembly • Array Interface Card (AIC) will begin assembly following successful testing of the AIC test bed board. • CIC and Backplane are in testing • Power Control Assembly (PCA) assembly in progress. • Microshutter Shock • An updated specification with significantly reduced shock levels has been developed and flowed to the MSA • The MSA structural model has been tested at Astrium and the required shock levels were achieved • Shock testing on the qualification Microshutter Array will be performed at Astrium, Freidrichshafen Germany the week of May 25

  21. OA Cover Achievements: • DM delivered and mounted • Design improved • FM manufacturing started Next steps: • FM manufacturing & delivery

  22. Science Support & IPS • DM/ETU NIRSpec • NIRSpec as an imager (detector in the MSA plane) • Not the actual flight hardware • Probing the distortion and image quality of the NIRSpec “imaging” stage independently from the spectrographic stage • Not possible at FM level NIRS-CRAL-PL-0007 • FM NIRSpec • The complete NIRSpec with the flight hardware • One month of cryogenic time dedicated to the calibration / characterization of the instrument. • Dedicated OGSE providing the necessary illumination patterns and sources. NIRS-CRAL-PL-0001

  23. Science Support & IPS • Key points FM calibration • Most extensive campaign prior the commissioning phase ! • Build the set of calibration files necessary to prepare the NIRSpec data processing software. Deliverable to NASA/STScI. • As far as possible, allow an early validation of some key NIRSpec operation and calibration concepts / schemes. • Wavelength calibration, target acquisition… • Major NIRSpec-level calibration items • Calibration of the “coordinate transforms” between the OTE focal plane and the detector plane (for TA !) • Calibration of the MOS spectrographic modes • Extensive and time-consuming calibration! • Classical spectrographic calibration steps • Calibration of the SLIT and IFU spectrographic modes. • Characterization of NIRSpec radiometric response

  24. TV Facility Achievements: • TV facility aceptance achieved (3 blank tests performed) • NIRSpec DM/ETU in cold test now Next steps: • Completion of cold test • Prepare FM test campaign

  25. JWST Partner’s Workshop NIRSpec Status • Status of Instrument Activities • Subcontractor Status This document is the property of Astrium. It shall not be communicated to third parties without prior written agreement. Its content shall not be disclosed. • Programmatic Status & Looking 6 month ahead

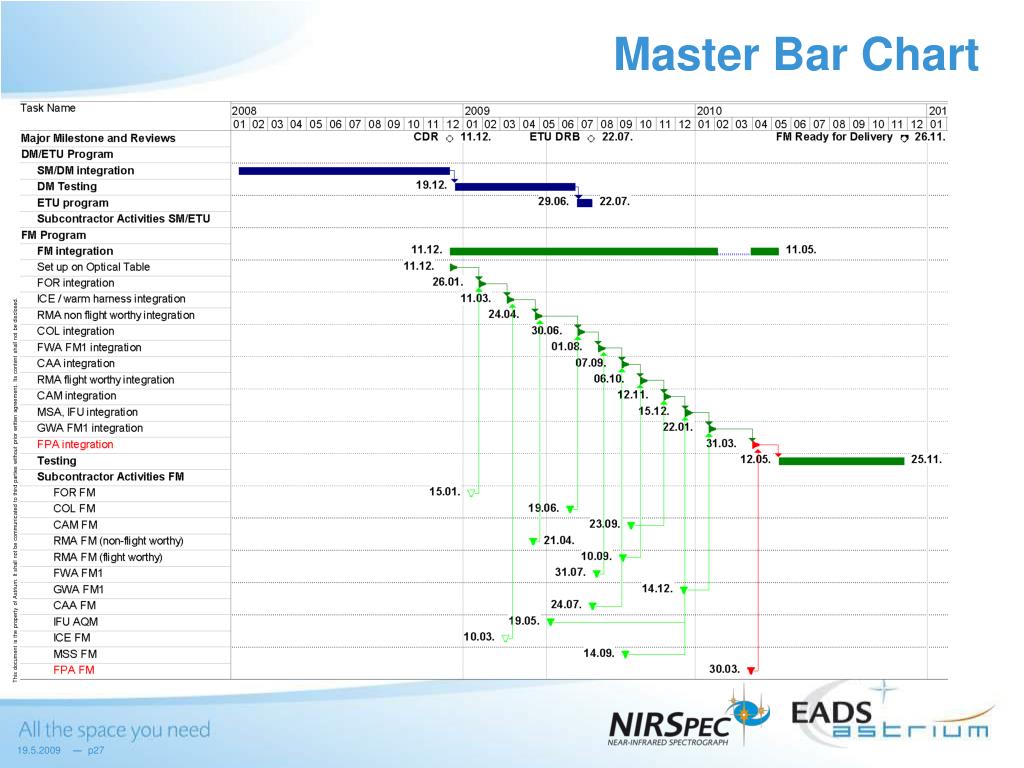

  26. Master Bar Chart

  27. Locking 6 month ahead • completion of DM/ETU test program and delivery • integration of the Flight Model •  Flight hardware gets more and more ready to be used in space!

  28. End of 2008
