Value-for-money in practice. EU Twinning Project: “Implementing PPP policy”. 6 June 2008. Content. On Value-for-Money in practice: Real-life examples Its sources Its drivers Its management The affordability-dilemma The do’s and don’ts. Morning session. Afternoon session.

keith
Download Presentation

Value-for-money in practice

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Value-for-money in practice EU Twinning Project: “Implementing PPP policy” 6 June 2008

  2. Content • On Value-for-Money in practice: • Real-life examples • Its sources • Its drivers • Its management • The affordability-dilemma • The do’s and don’ts Morning session Afternoon session

  3. Real-life examples

  4. N31 Motorway Project • A 25 km provincial road • Upgrading to a two-lane motorway • Road infrastructure, bridge and aqueduct. • DBFM-contract • Contract value: € 80 million • Contract duration: 15 years

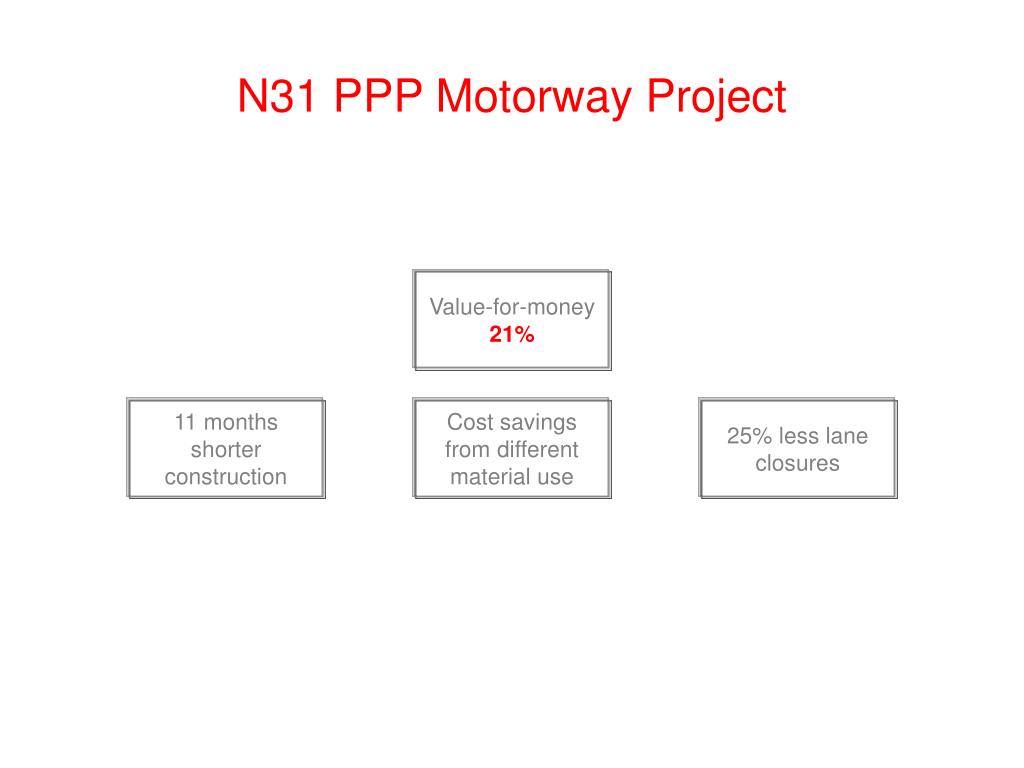

  5. Value-for-money 21% 11 months shorter construction Cost savings from different material use 25% less lane closures N31 PPP Motorway Project

  6. A’dam – Brussels High Speed Rail Link • A 125 km high-speed rail line • Greenfield + Upgrading existing rail • Infrastructure and superstructure. • 2 DBFM-contracts / 1 O-contract • Contracts value: € 7 billion • Contract duration: 15 – 25 years

  7. A’dam – Brussels High Speed Rail Link Value-for-money 2% Greater availability Non-application of unproven technologies Embedded-rail

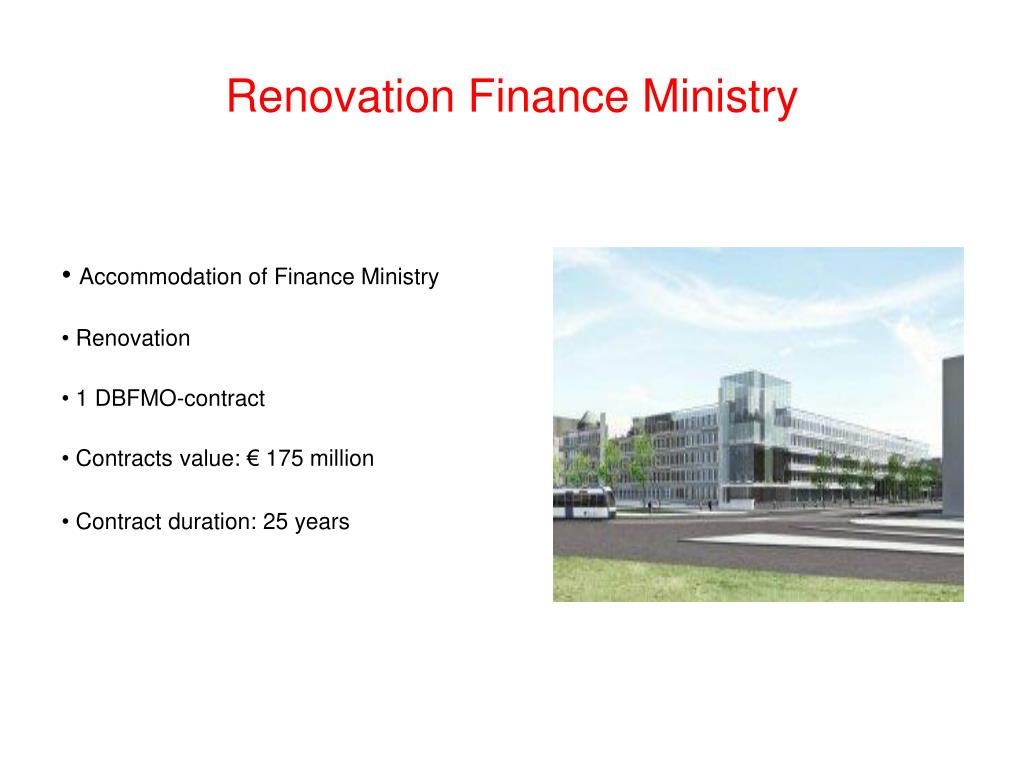

  8. Renovation Finance Ministry • Accommodation of Finance Ministry • Renovation • 1 DBFMO-contract • Contracts value: € 175 million • Contract duration: 25 years

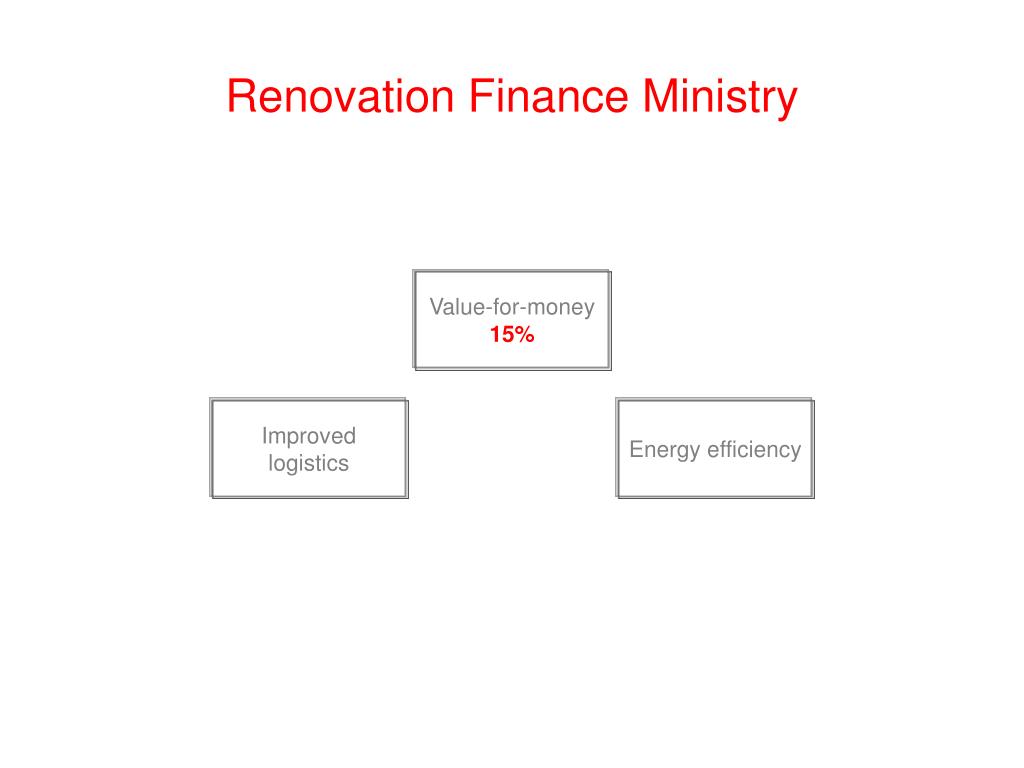

  9. Renovation Finance Ministry Value-for-money 15% Improved logistics Energy efficiency

  10. Montaigne School Building • School building • Greenfield • DBFM-contract • Contracts value: € 27 million • Contract duration: 30 years

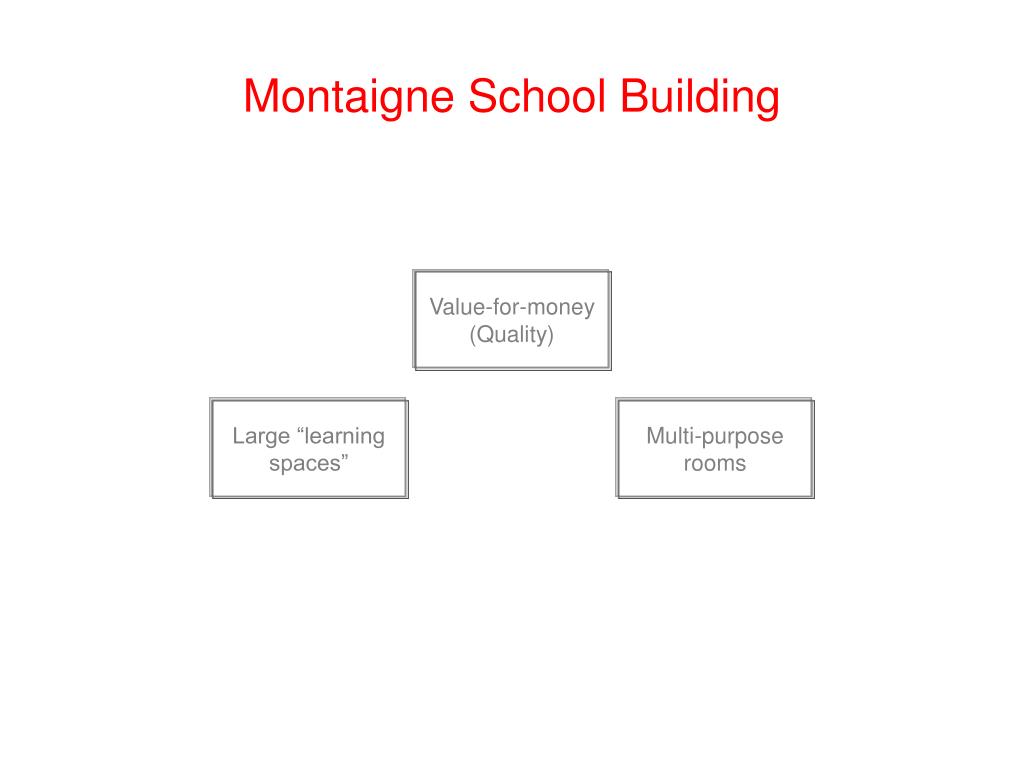

  11. Montaigne School Building Value-for-money (Quality) Large “learning spaces” Multi-purpose rooms

  12. Delfuent Water Sanitation Plant • Water sanitation plant • Greenfield & modernization • DBFMO-contract • Contracts value: € 450 million • Contract duration: 30 years

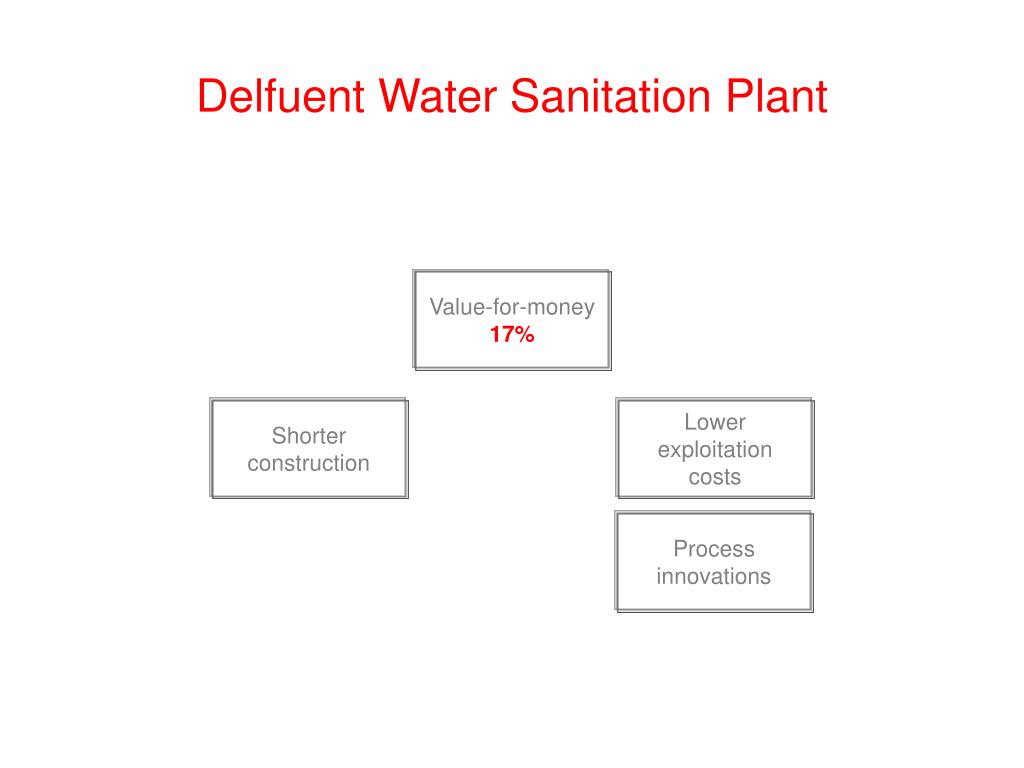

  13. Delfuent Water Sanitation Plant Value-for-money 17% Shorter construction Lower exploitation costs Process innovations

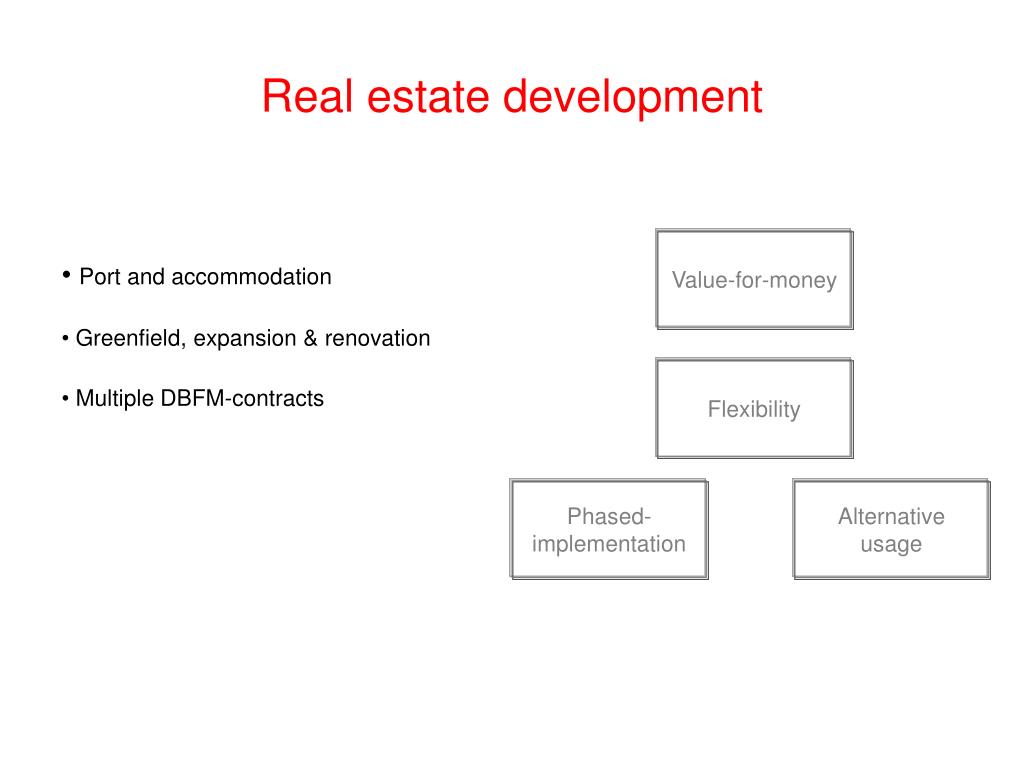

  14. Real estate development • Port and accommodation • Greenfield, expansion & renovation • Multiple DBFM-contracts Value-for-money Flexibility Phased-implementation Alternative usage

  15. The sources of value-creation

  16. Quality The main principles

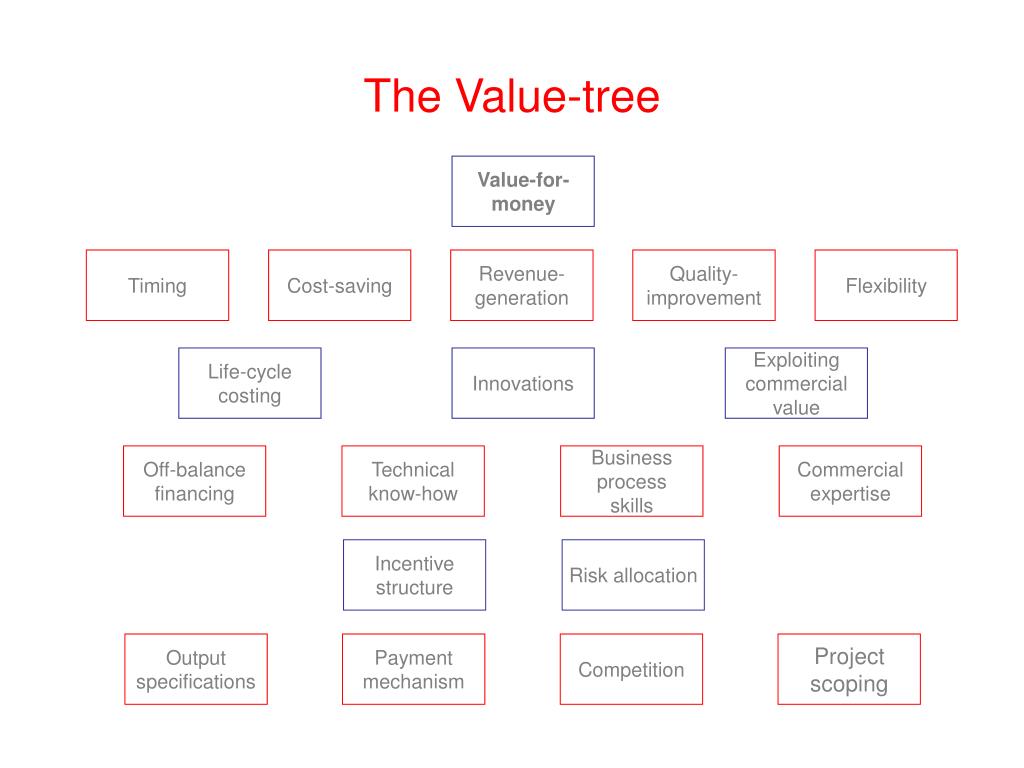

  17. The Value-tree Value-for-money Timing Cost-saving Revenue-generation Quality-improvement Flexibility Life-cycle costing Innovations Exploiting commercial value Off-balance financing Technical know-how Business process skills Commercial expertise Incentive structure Risk allocation Output specifications Payment mechanism Competition Project scoping

  18. Key Value-drivers: N31 Motorway Project

  19. Output specifications Functional output specifications on safety and comfort standards By Ministry of Transport Technical specifications By private partner Conditions tree

  20. Responsibility matrix

  21. Risk allocation

  22. Financial selection criteria Market testing € Procurement Contract implementation Qualitative Minimum requirements Payment mechanism Output specifications Incentive structure

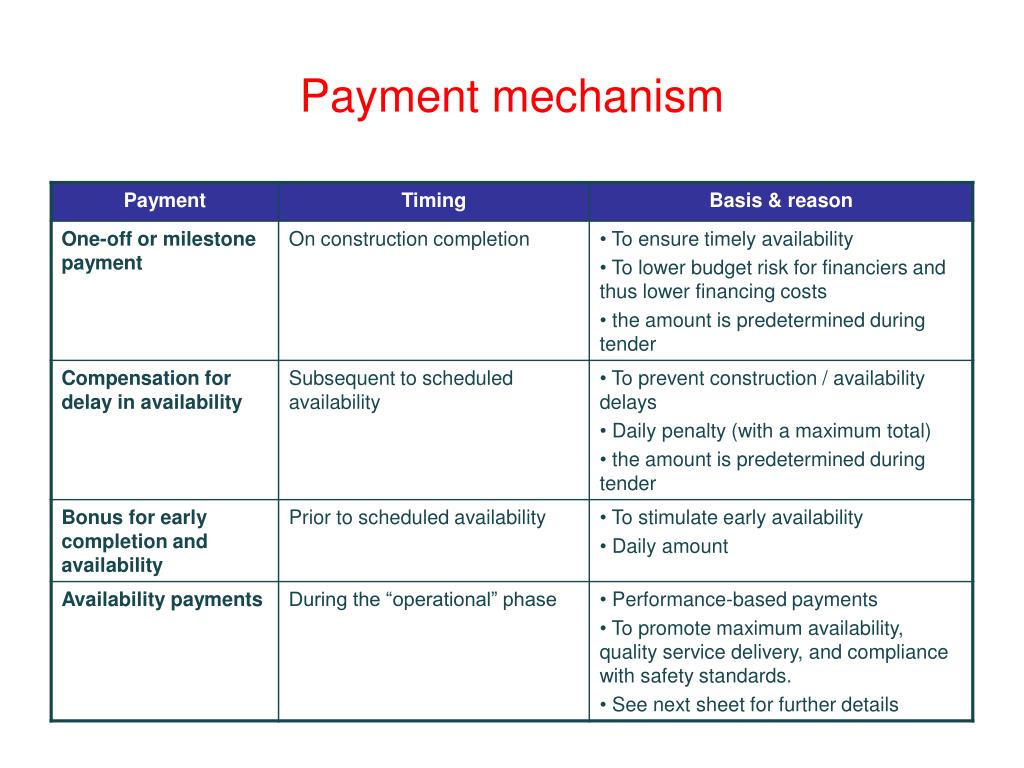

  23. Payment mechanism

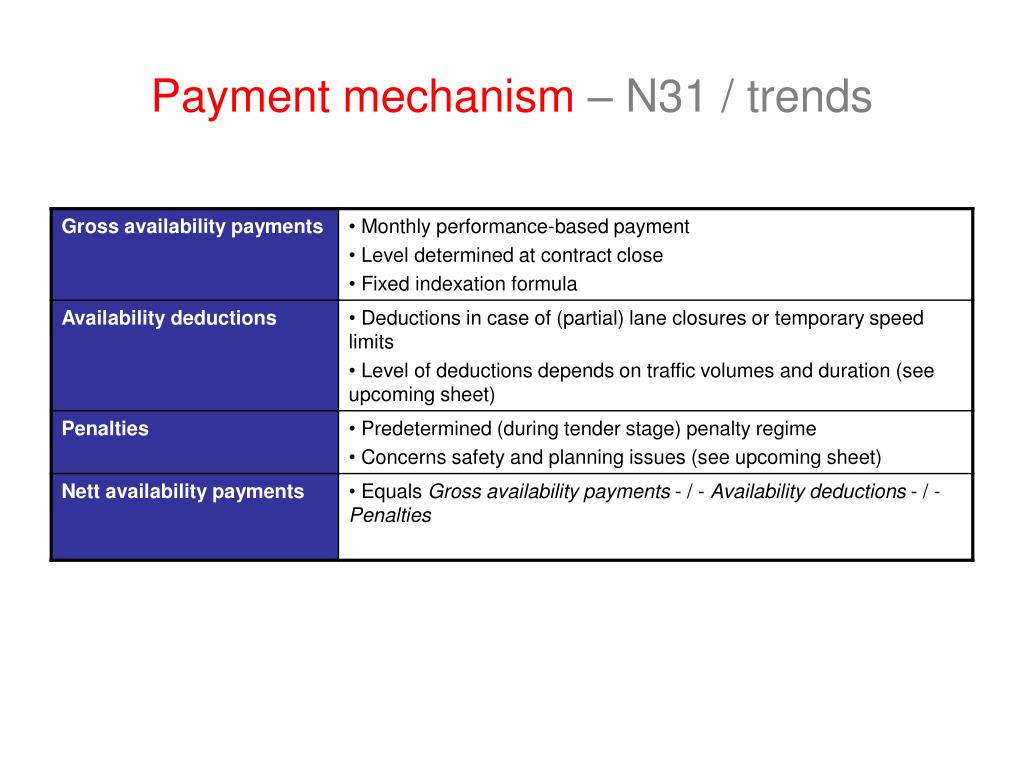

  24. Payment mechanism – N31 / trends

  25. Payment mechanism

  26. Payment mechanism

  27. Competition Competitive dialogue procedure Stages Selection Phase Dialogue Phase 1 Dialogue Phase 2 Final Evaluation Phase Dialogue Phase 3 Final Negotiation phase Preperation for Realisation Realisation Phase Operation Phase Key Decision-making points Announcement Invitation for Dialogue Ph. 1 (Incl. Selection) Invitation for Dialogue Ph. 2 (Incl. Shortlist of three firms) Invitation for Submission BAFO Selection of preferred bidder Contract close / financial close Aanvangs-certificaat Certificate of Commence-ment Invitation for Dialogue Ph. 3 (optional) Certificate of Completion Oplevering

  28. Value-for-money management

  29. Process, instruments and time Dynamic PPC Qualitative Quantitative Conventional implementation PPP potential scan Time PPP implementation Business case Request for proposals Procurement 6 months 6 months

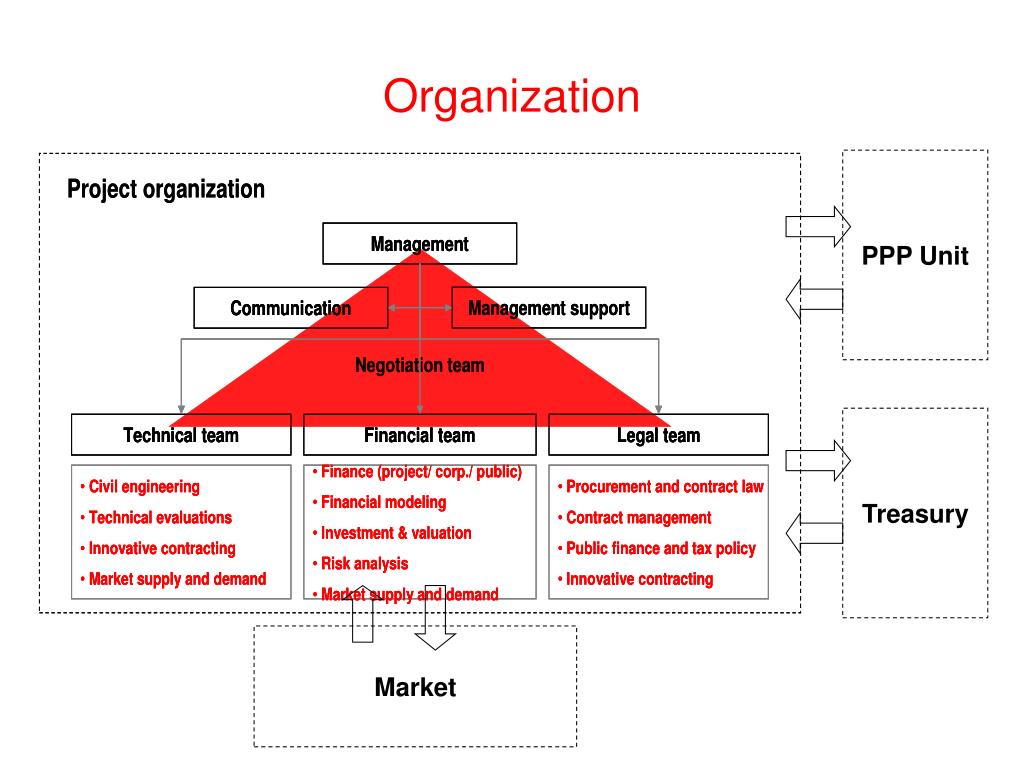

  30. Organization PPP Unit Treasury Market

  31. Contract management Private consortium Project organization Ministry of Transport Project organization Process management / supervision Quality management plan Contract management plan Show performance and contract compliance Quality supervision Civil works Maintenance activities

  32. Contract management Ministry of Transport Verify process Verify product quality Main focus’ Process control Product control Private consortium Contract management plan Quality Management Plan product process On an exceptional basis Check process directly Check product directly

  33. The affordability-dilemma

  34. Conflicting objectives Optimal risk transfer Value-for-money Affordability Risk transfer to private sector

  35. The do’s and don’ts

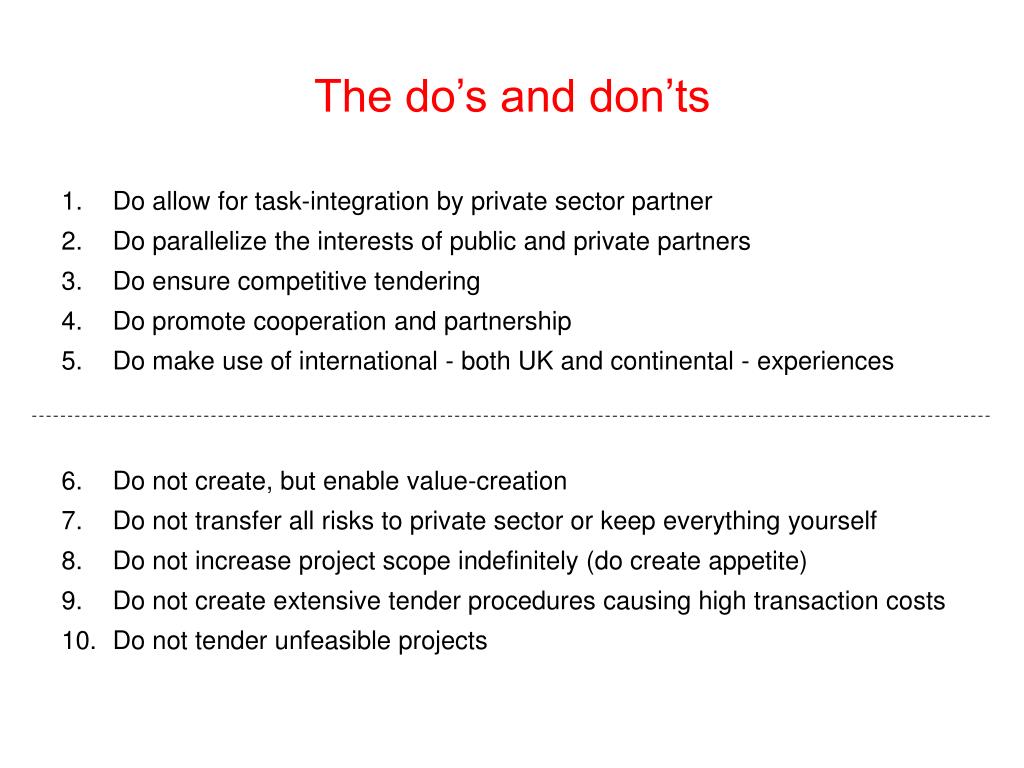

  36. The do’s and don’ts • Do allow for task-integration by private sector partner • Do parallelize the interests of public and private partners • Do ensure competitive tendering • Do promote cooperation and partnership • Do make use of international - both UK and continental - experiences • Do not create, but enable value-creation • Do not transfer all risks to private sector or keep everything yourself • Do not increase project scope indefinitely (do create appetite) • Do not create extensive tender procedures causing high transaction costs • Do not tender unfeasible projects

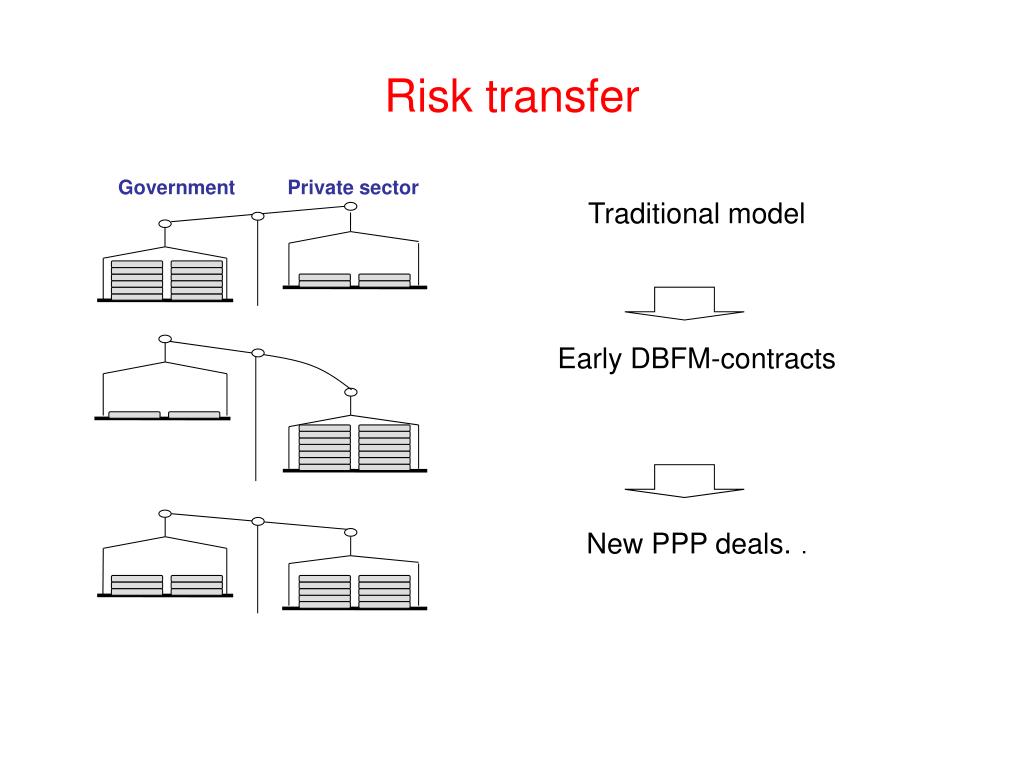

  37. Risk transfer Government Private sector • Traditional model • Early DBFM-contracts • New PPP deals..

  38. Contact information Rebelgroup Advisory BV Geert Engelsman Wijnhaven 3-O, 3011 WG Rotterdam, The Netherlands Tel +31 10 2755995 Fax +31 10 2755999 www.rebelgroup.nl geertjan.engelsman@rebelgroup.nl
