An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. West Haymarket redevelopment projects Project Status Update November 2nd, 2012

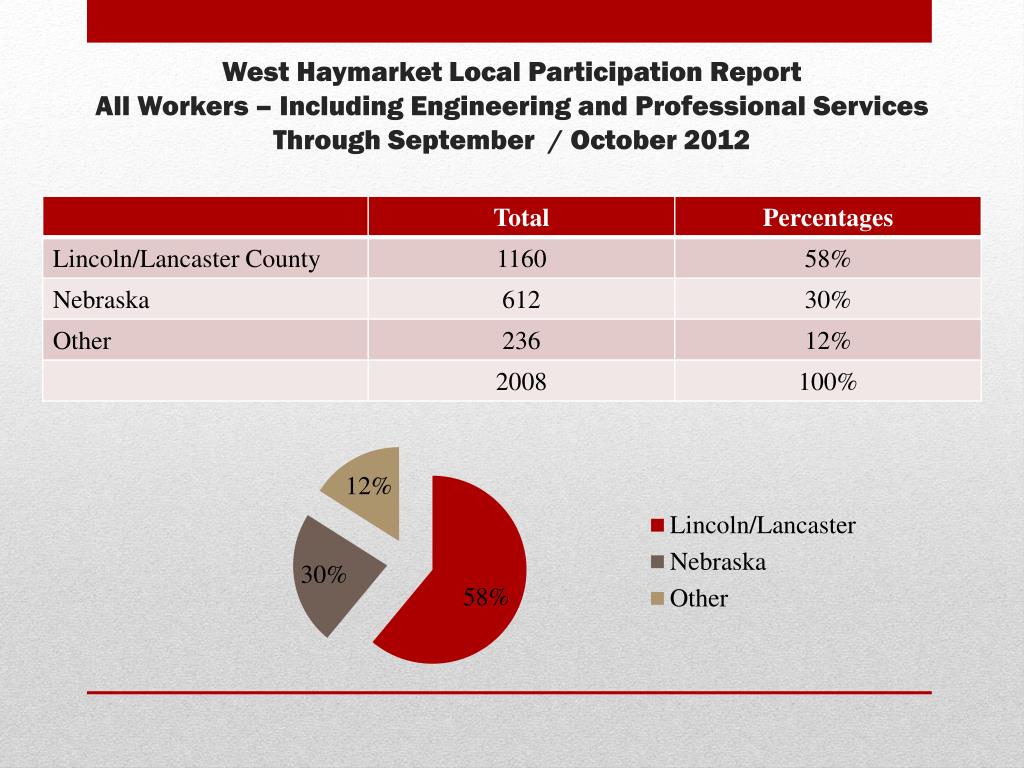

  2. West Haymarket Local Participation ReportAll Workers – Including Engineering and Professional ServicesThrough September / October 2012

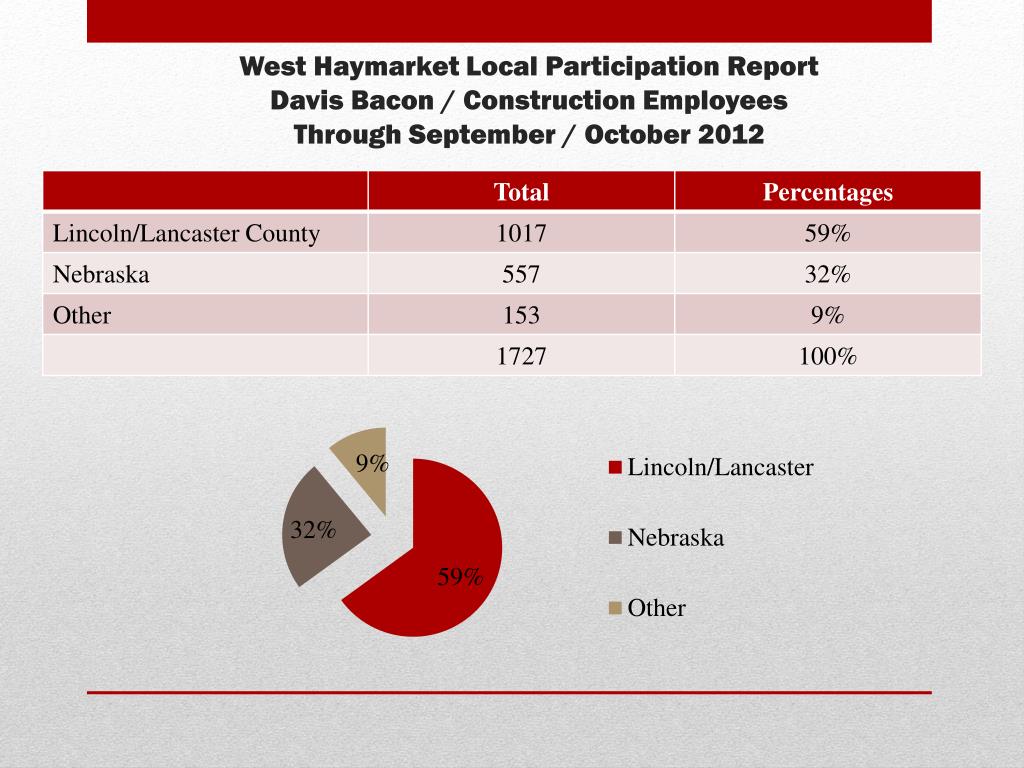

  3. West Haymarket Local Participation ReportDavis Bacon / Construction EmployeesThrough September / October 2012

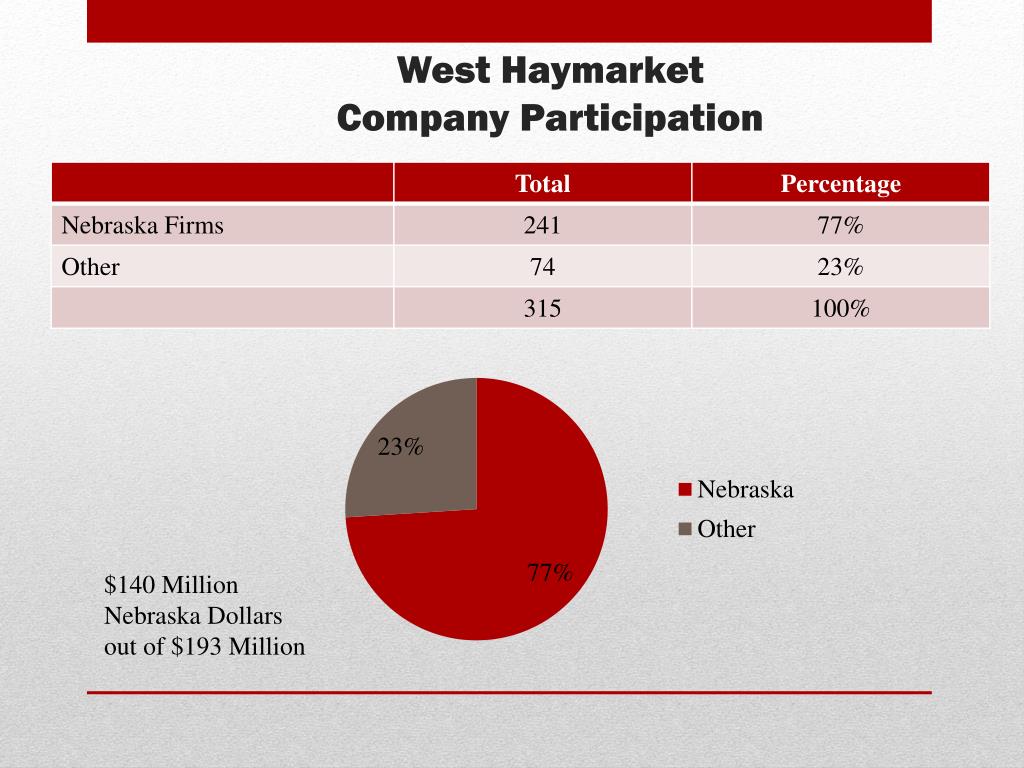

  4. West HaymarketCompany Participation $140 Million Nebraska Dollars out of $193 Million

  5. Infrastructure Progress

  6. ARENA & LOFTS FROM 7TH & Q STREET

  7. FORMER IRONHORSE PARKING LOT BEING GRADED FOR DEVELOPMENT

  8. NORTH HALF OF “R” STREET

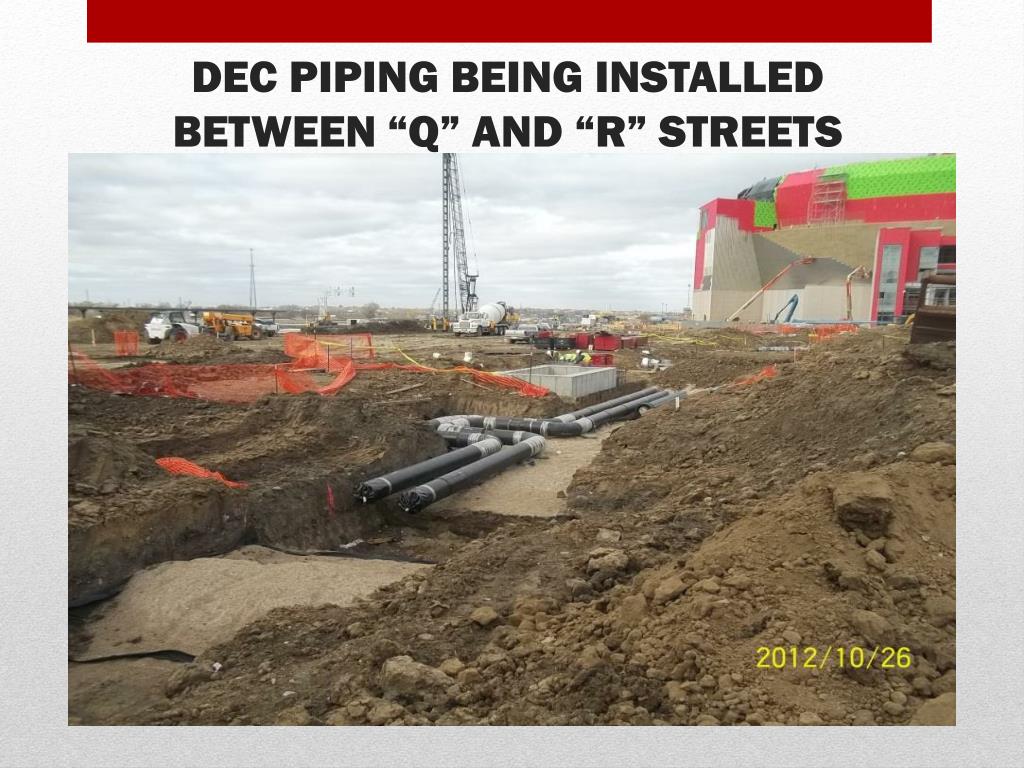

  9. DEC PIPING BEING INSTALLED BETWEEN “Q” AND “R” STREETS

  10. NEW PINNACLE BANK ARENA DRIVE, LOOKING NORTH FROM “Q” STREET

  11. WATER MAIN CONSTRUCTION NEAR “N” STREET AND PINNACLE ARENA DRIVE

  12. ARENA PLAZA & PEDESTRIAN BRIDGE SHARED PIER CONSTRUCTION

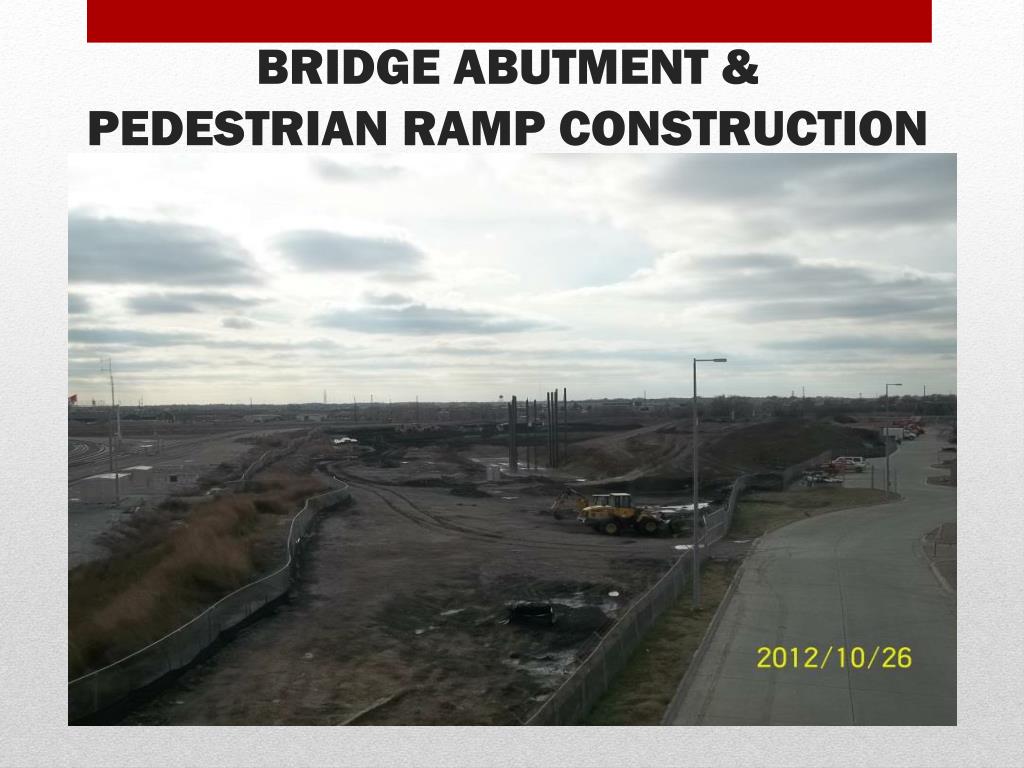

  13. BRIDGE ABUTMENT &PEDESTRIAN RAMP CONSTRUCTION

  14. PEDESTRIAN BRIDGE ABUTMENT CONSTRUCTION

  15. OVERALL AERIAL OCTOBER 15, 2012

  16. Presentation to the JPA November 2, 2012

  17. Safety • Worked 141 consecutive days without a safety incident • The Project averages over 250 Craft Workers daily

  18. Concrete Superstructure • The concrete work continues with Slab on Grade and Slab on Metal Deck • Garage Foundations have been poured, work continues on Garage walls

  19. Installing Plywood for Club Roof

  20. Milestones Achieved • 1st Phase of structural precast is complete • All four long span trusses are installed • 50% of Metal Deck Installed • Roofing Installation started • Metal Panel Installation started • Curtainwall Installation started

  21. Installing Exterior Studs

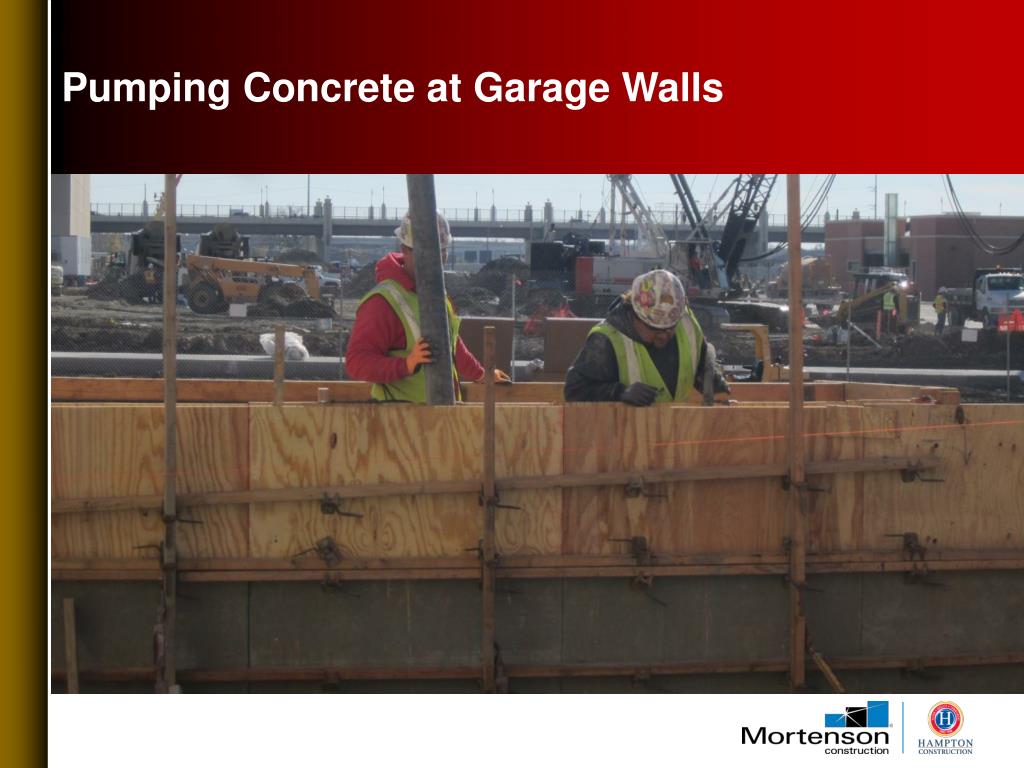

  22. Pumping Concrete at Garage Walls

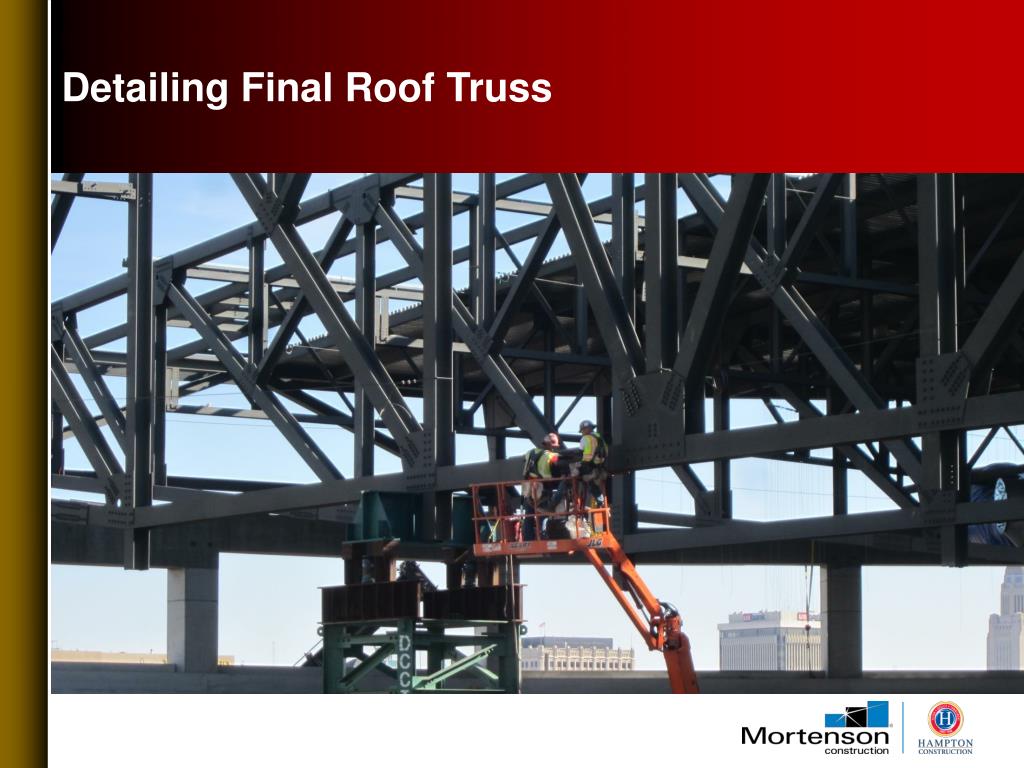

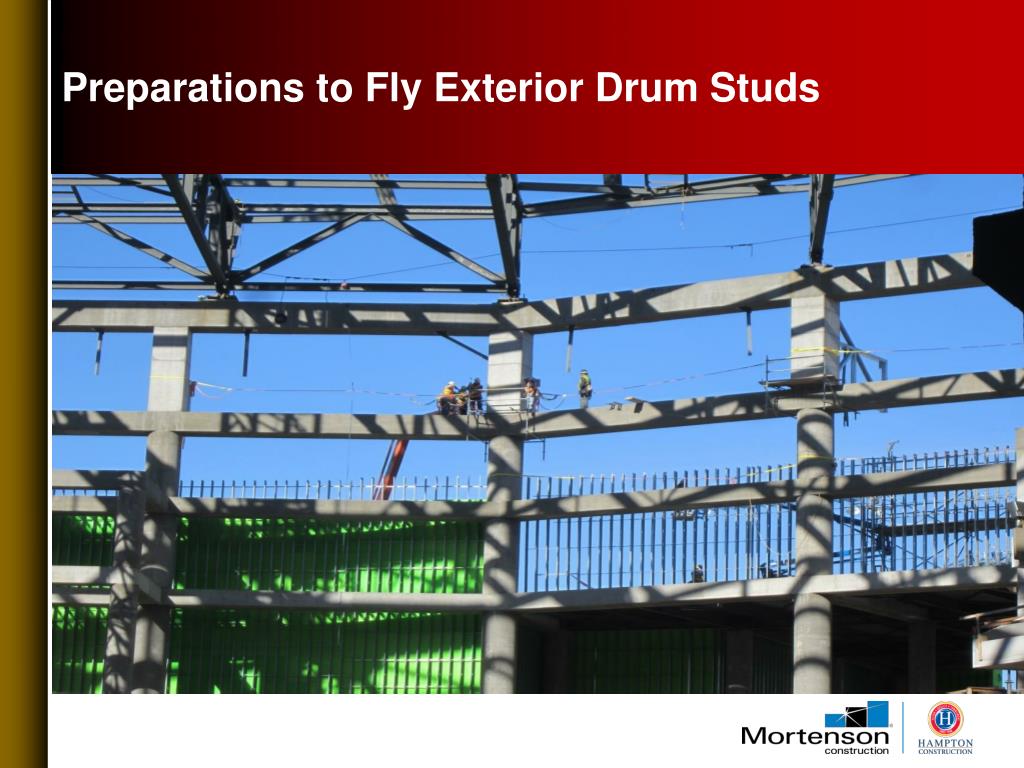

  23. Detailing Final Roof Truss

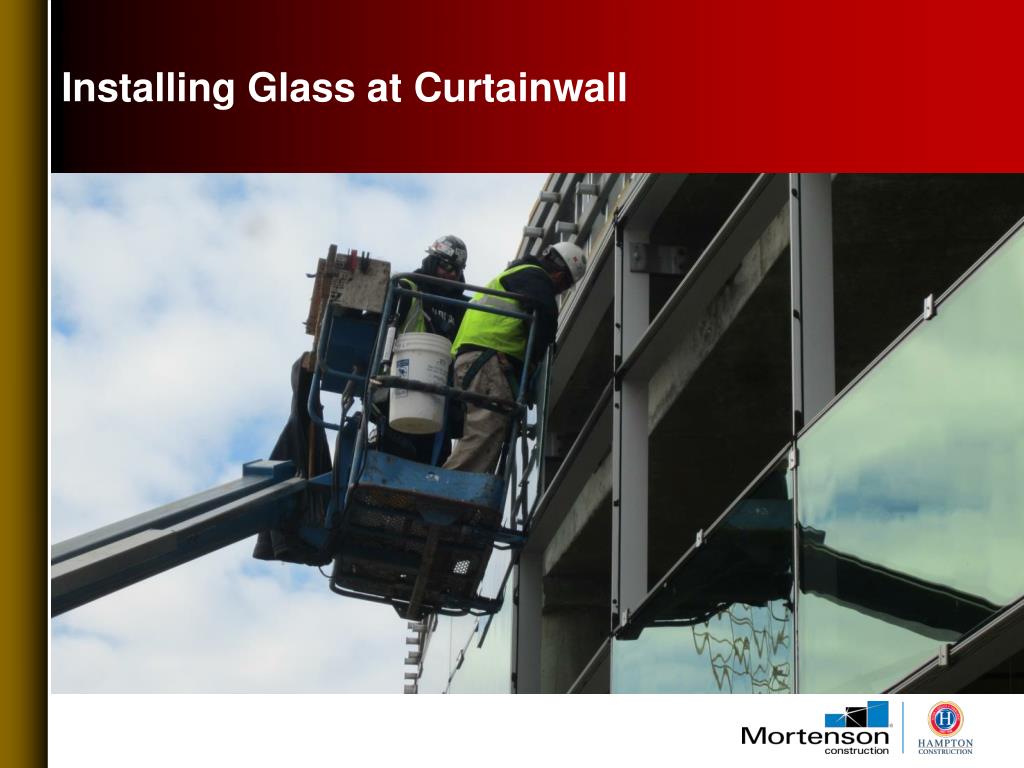

  24. Installing Glass at Curtainwall

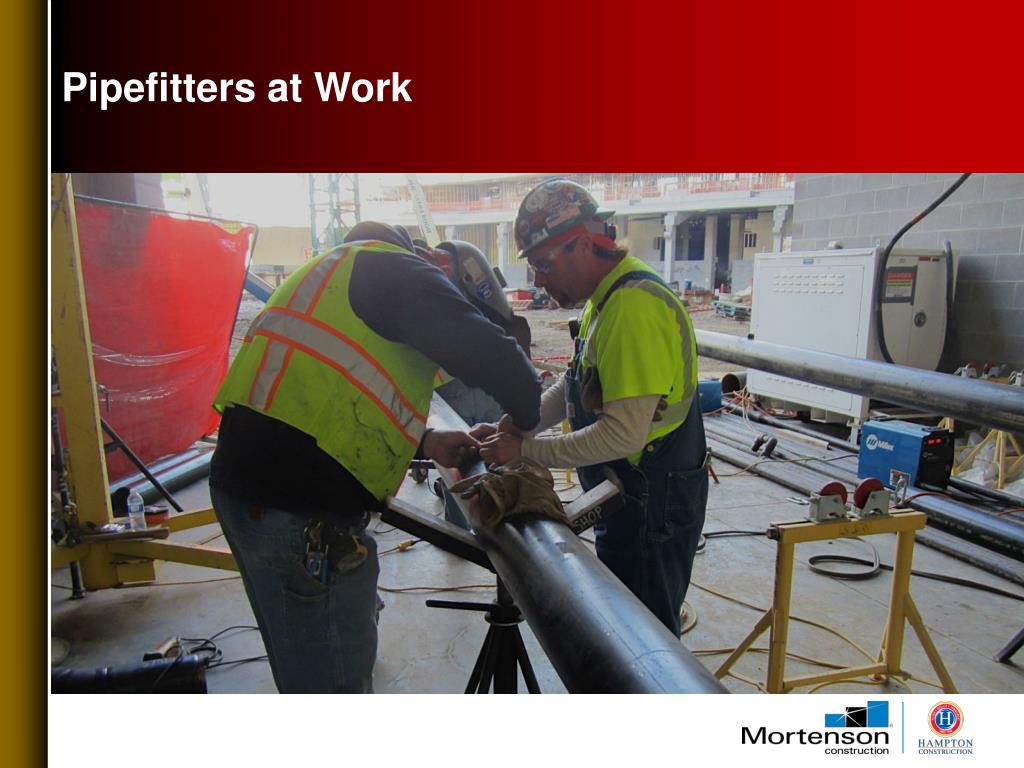

  25. Pipefitters at Work

  26. Preparations to Fly Exterior Drum Studs

  27. Flying High Drum Stud Frame Into Place

  28. Installing the 3rd Exit Stair
