1 / 9

CMS End Cap Muon Chambers MP9 Production Readiness Review Follow-up June 29, 2000

CMS End Cap Muon Chambers MP9 Production Readiness Review Follow-up June 29, 2000. Nelson Chester Project Engineer Considerations Since Last Review Design & Drawing Status Chambers Tooling Chamber Configuration Control Manpower Status & Plans Concerns and Pending Changes

marie
Download Presentation

CMS End Cap Muon Chambers MP9 Production Readiness Review Follow-up June 29, 2000

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. CMS End Cap Muon ChambersMP9 Production Readiness Review Follow-upJune 29, 2000 Nelson Chester Project Engineer • Considerations Since Last Review • Design & Drawing Status • Chambers • Tooling • Chamber Configuration Control • Manpower Status & Plans • Concerns and Pending Changes • Summary and Conclusions 2nd MP9 Production Readiness Review

  2. Background Considerations • Of the 5 chamber types only ME23/2 (largest chamber) will be assembled at Fermilab in MP 9. • A quantity of 144 + 2 spares chambers of this type required…. 4 Chambers completed as of 7/1/00. • Goal - To complete production in June, 2003 - 3.0 years. • Must Complete 74 chambers by Jan. 2002 2nd MP9 Production Readiness Review

  3. Changes Since Last Review • Responsibility for Frame Design and Procurement moved from UWM to Fermilab. Means added Resources Required to Complete Designs, Procurement, Inspection and Kit Preparation • Added New Wiring Harness with 19 Pin HV Connectors to Replace 7 and 13 Pin Connectors • Frame features modified to accommodate New HV Connector Wiring Harness, Electronics Cooling Plate, and Cathode Cable Strain Relief • Ground Lugs added to Panels at each Strip Connector • Retro-Reflective Targets and Alignment Strips added to Inner Cathode Panels (2 on wide end & 2 on narrow end) • Gas fittings added to Bulkhead Connectors • Bleed Resistors (SIP’s) added to Ground Strips • Modified Anode Side Panels (added holes) and Anode Protection Boards (removed latches) to Accommodate Anode Front End Circuit Cards 2nd MP9 Production Readiness Review

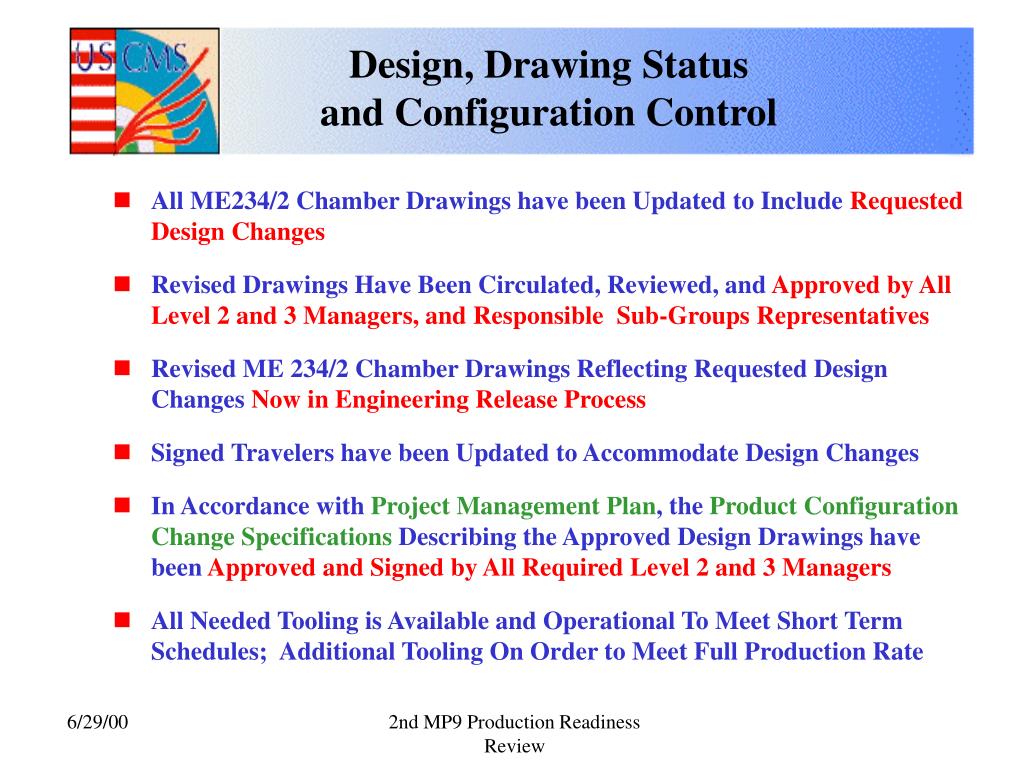

  4. Design, Drawing Statusand Configuration Control • All ME234/2 Chamber Drawings have been Updated to Include Requested Design Changes • Revised Drawings Have Been Circulated, Reviewed, and Approved by All Level 2 and 3 Managers, and Responsible Sub-Groups Representatives • Revised ME 234/2 Chamber Drawings Reflecting Requested Design Changes Now in Engineering Release Process • Signed Travelers have been Updated to Accommodate Design Changes • In Accordance with Project Management Plan, the Product Configuration Change Specifications Describing the Approved Design Drawings have been Approved and Signed by All Required Level 2 and 3 Managers • All Needed Tooling is Available and Operational To Meet Short Term Schedules; Additional Tooling On Order to Meet Full Production Rate 2nd MP9 Production Readiness Review

  5. Lab 8 Manpower • Panel Production Rate is Met with the Planned 2.4 FTE Rate • Current Rate is Down due to Loss of Valued Worker • Adequate Supply of Finished Panels (50%of Required) to Meet Production Needs • Some Catch-up May Be Required if Delays Persist 2nd MP9 Production Readiness Review

  6. MP9 Manpower • Current Labor Force at 5 Technicians • Two Chambers Essentially Produced in June with 4-5 Technicians • Will Grow to 7 Technicians by November, 2000 2nd MP9 Production Readiness Review

  7. Materials Control Plan • Procurement, Inventory, Inspection, and Kit Preparation for Frame Parts in addition to other Chamber Parts now Responsibility of TD Materials Control Group • One FTE to be Added to IB4 Group to Handle Inventory and Kit Preparation • One Half FTE for 2 years to be Added to Procurement Group to Handle Additional Frame Load 2nd MP9 Production Readiness Review

  8. Concerns and Pending Changes • Alternate High Voltage Connectors are being Considered • Decision to be Made by End July • Estimated Cost ~50% of Baseline • Readily Available - CERN Can Produce • Production Testing of Chambers May Continue Without High Voltage Harness • Minor Additional Work Required to Add Harness Later • Frame Extrusions Must Be Procured Soon 2nd MP9 Production Readiness Review

  9. Summary and Conclusions • Four Chambers Successfully Completed Using Only Production Tooling Consistent With Configuration Requirements • All Materials Available To Continue Production; Available Tooling is Adequate with Additional Tooling Ordered to Accommodate Ramp Up • Current Staff and Hiring Plans are Adequate to Meet Production Needs • All Technical Documentation (Drawings, Specifications, and Travelers) In Place and Being Used • Ramp Up Requirements Understood and Addressed 2nd MP9 Production Readiness Review

More Related
