Dry Stacking of Cycloned Tailings

Dry Stacking of Cycloned Tailings. W. Lugão - VOGBR, Brazil M. Almeida - VOGBR, Brazil A. Guimarães - VOGBR, Brazil F. Magalhães - VOGBR, Brazil S. Mohallem - ARCELORMITTAL, Brazil. Introduction.

nan
Download Presentation

Dry Stacking of Cycloned Tailings

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Dry Stacking of Cycloned Tailings W. Lugão - VOGBR, Brazil M. Almeida - VOGBR, Brazil A. Guimarães - VOGBR, Brazil F. Magalhães - VOGBR, Brazil S. Mohallem - ARCELORMITTAL, Brazil

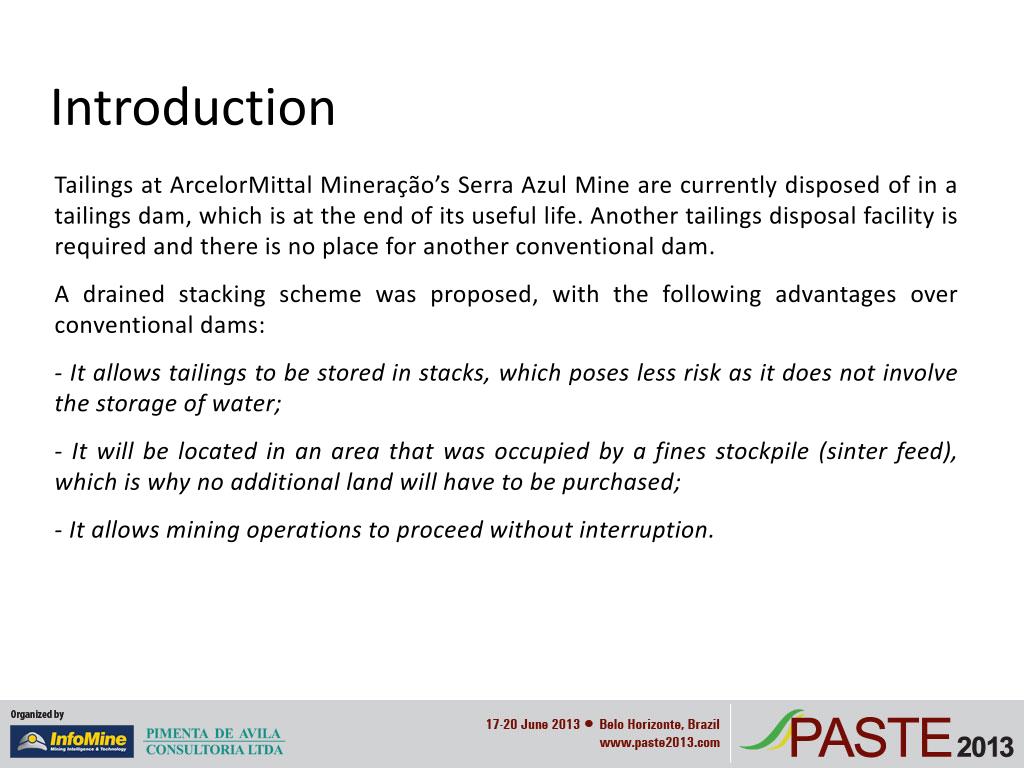

  2. Introduction • Tailings at ArcelorMittal Mineração’s Serra Azul Mine are currently disposed of in a tailings dam, which is at the end of its useful life. Another tailings disposal facility is required and there is no place for another conventional dam. • A drained stacking scheme was proposed, with the following advantages over conventional dams: • - It allows tailings to be stored in stacks, which poses less risk as it does not involve the storage of water; • - It will be located in an area that was occupied by a fines stockpile (sinter feed), which is why no additional land will have to be purchased; • - It allows mining operations to proceed without interruption.

  3. IMAGE: 09-14-2007 – GOOGLE EARTH SERRA AZUL MINE TAILINGS DAM SINTER FEED

  4. IMAGE: 07-30-2011 – GOOGLE EARTH SERRA AZUL MINE TAILINGS DAM DRY STACKING TAILINGS

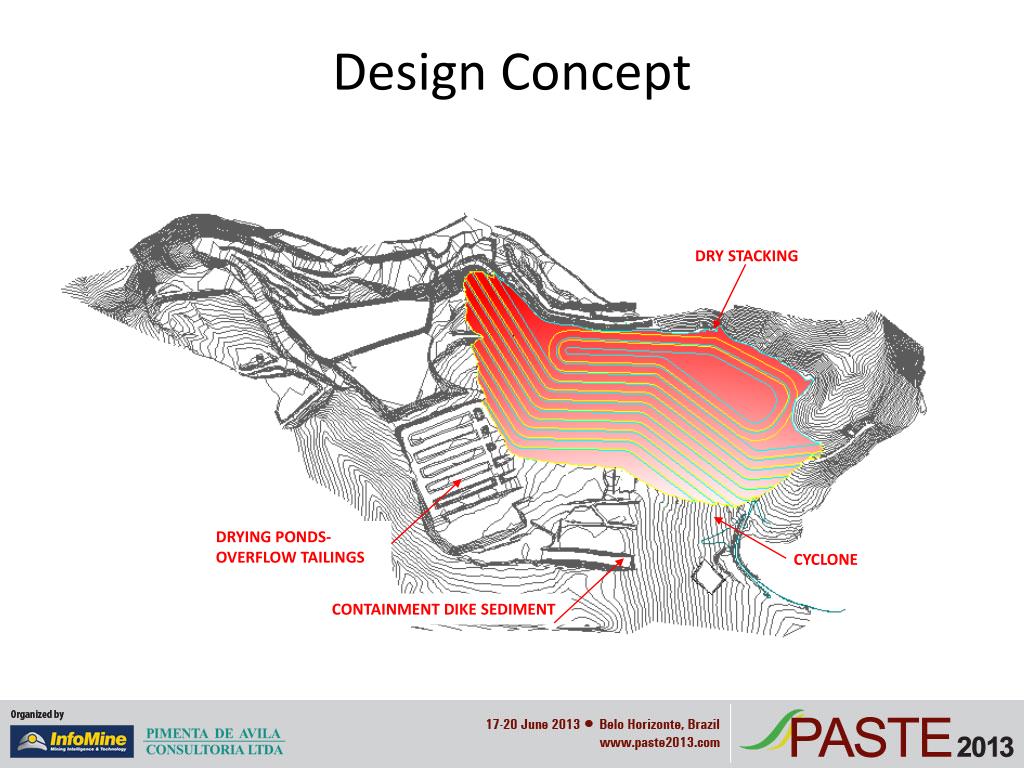

  5. DRY STACKING DRYING PONDS- OVERFLOW TAILINGS CONTAINMENT DIKE SEDIMENT Design Concept CYCLONE

  6. WASTE PILE Design Concept A • WASTE/TAILINGS CO-DISPOSAL DRY STACKING

  7. Internal drainage Design Concept DRAIN - SECTION JIG TAILINGS ROCK-FILL STARTER EMBANKMENT

  8. Example: Plant level 1,030 m – tailings/waste co-disposal Design Concept A SECTION A WASTE PILE OVERFLOW / UNDERFLOW TAILINGS JIG TAILINGS UNDERFLOW TAILINGS 8m 25m 100m ROCK-FILL STARTER EMBANKMENT TAILINGS CELLS

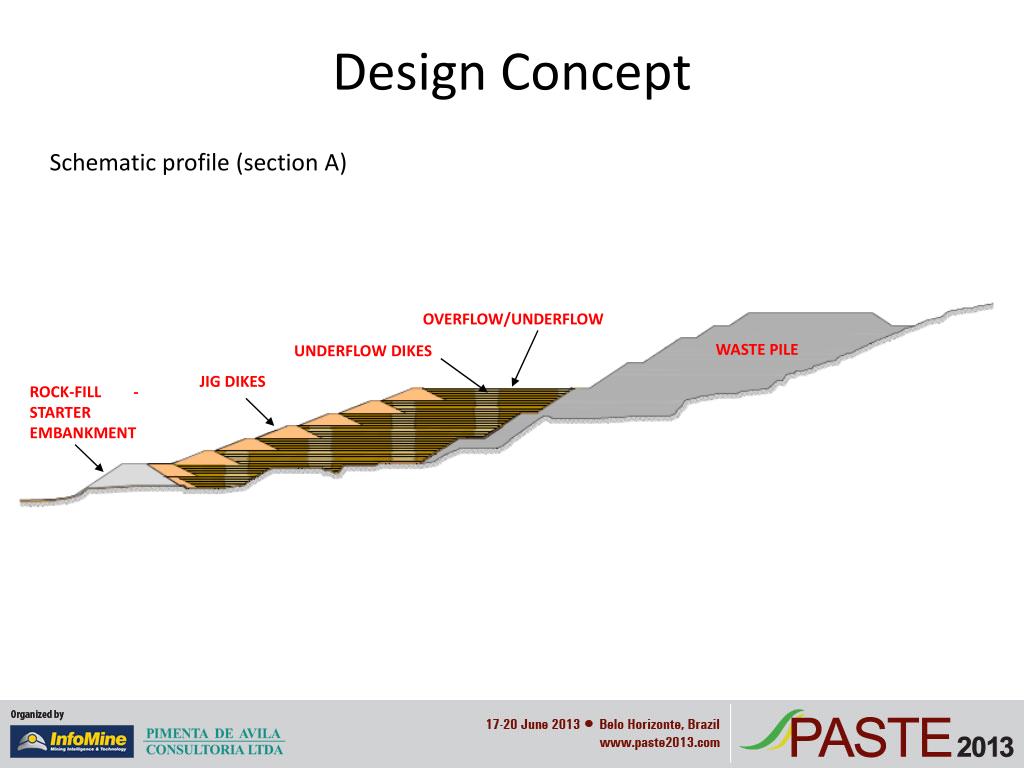

  9. Schematic profile (section A) Design Concept OVERFLOW/UNDERFLOW WASTE PILE UNDERFLOW DIKES JIG DIKES ROCK-FILL - STARTER EMBANKMENT

  10. Design Concept UNDERFLOW DIKES Conception: Underflow dikes – vertical drainage!!! Conception: Overflow – drainage in top and base!!!

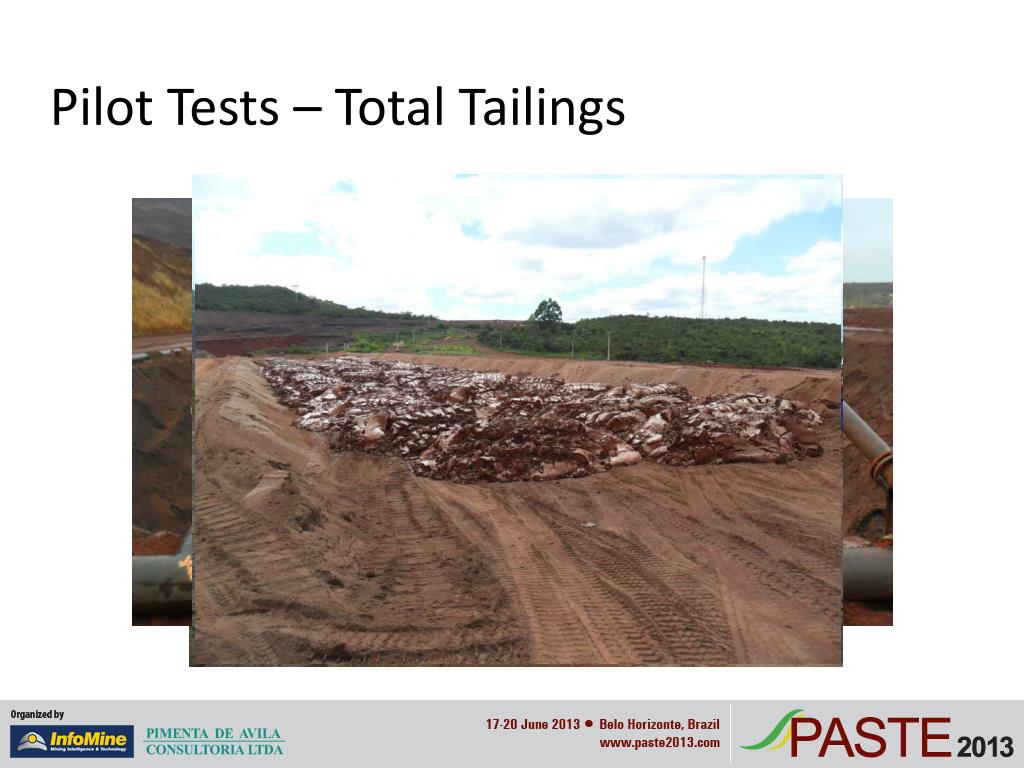

  11. Pilot Tests – Total Tailings

  12. Pilot Tests - Cyclone UNDERFLOW TAILINGS CYCLONE

  13. Tailings characterisation Percentfinerthan Jig Tailings Total Tailings AM01 Underflow AM02 Underflow Overflow Grainsize - millimeters

  14. Table - Test results Table - Permeability test summary

  15. Table 6 Parameters for materials used in stress-strain and stability analyses Table - Triaxial test results Table - Parameters for materials used in stress-strain and stability analyses

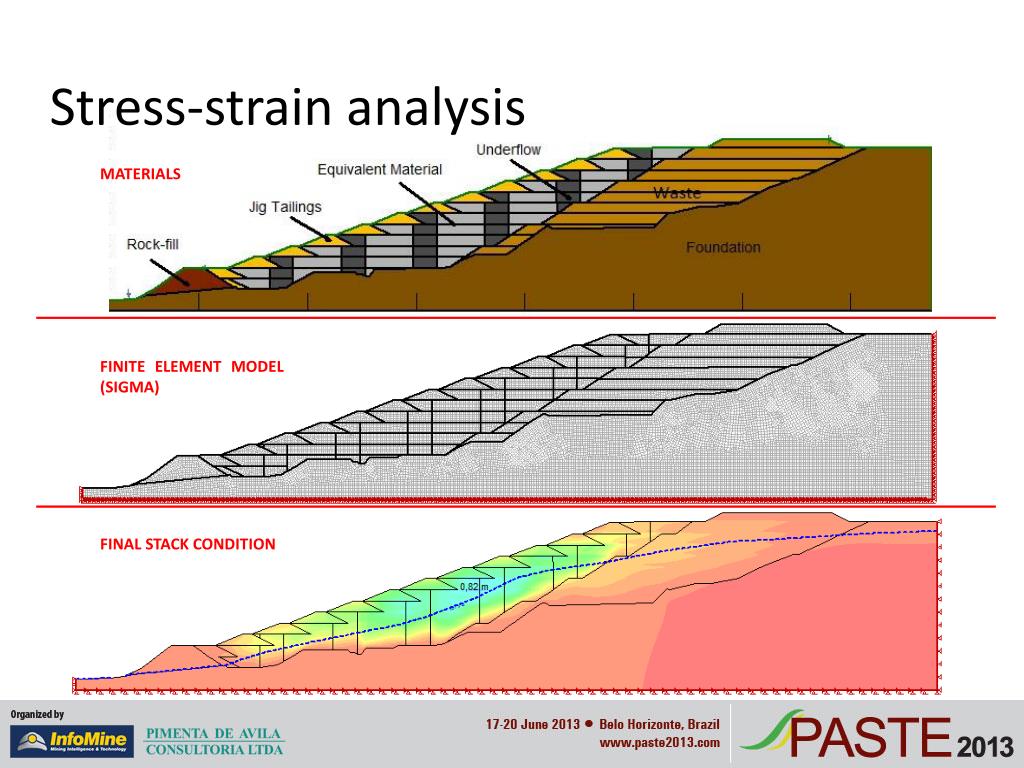

  16. Stress-strain analysis MATERIALS FINITE ELEMENT MODEL (SIGMA) FINAL STACK CONDITION

  17. Stability Analyses • The safety factor for the critical failure surface is 1.97 and is therefore satisfactory. Stability analysis results for waste rock/tailings co-disposal – Global – Non-Circular failure.

  18. Operation OVERFLOW TAILINGS – DISPOSAL SEQUENCE

  19. Building the tailings cells

  20. Situation - December 2012 DRYING PONDS ROCK-FILL - STARTER EMBANKMENT UNDERFLOW LEVEL 1000.5 m CONTAINMENT DIKE OVERFLOW LEVEL 1000 m

  21. Final Remarks • Stability analyses have arrived at a satisfactory safety factor, assuming the long-term (drained) final stack condition; the maximum predicted subsidence in dry stacks will be acceptable even in the most critical long-term condition; • It is suggested that the cyclone system operating techniques should be reviewed, as the system is now working with overflow rates in excess of design rates. As a result, underflow requirements are being filled with jig tailings currently available at the mine for such purpose. • It is also recommended that alternative methods should be developed for carrying overflow tailings from dewatering ponds to the storage basins, including alternative deposition methods, with a view to improving the process which is currently undertaken using trucks. • An investigation campaign is programmed, composed of SPT, CPTU, Vane, permeability and laboratory tests; • ArcelorMittal will continue monitoring the performance of the system.

  22. Thank you! • Contact: • wlugao@vogbr.com.br
