EVM at the FAA

EVM at the FAA. FAA Acquisition Management System (AMS). http://fast.faa.gov. Recent activity. December 2004 – included ANSI/EIA-748 compliance and IBR in FAA AMS policy January 2005 – created EVM Focal Point February 2005 – initiated EVM assessment of all OMB Exhibit 300 programs

padma
Download Presentation

EVM at the FAA

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. EVM at the FAA

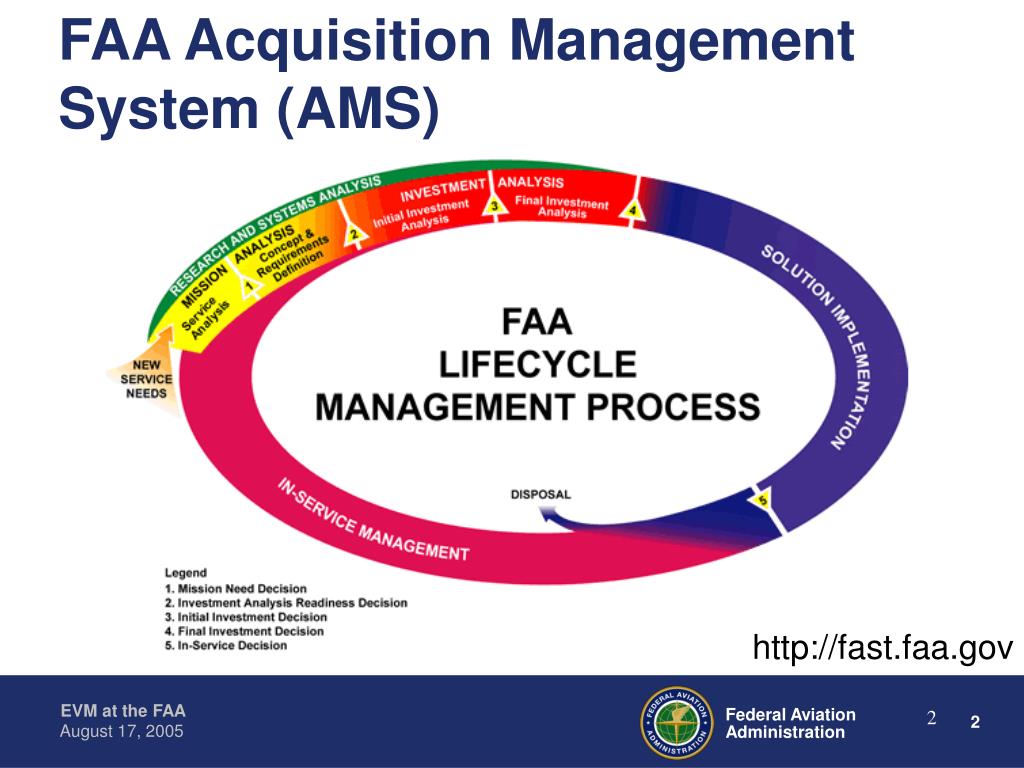

  2. FAA Acquisition Management System (AMS) http://fast.faa.gov

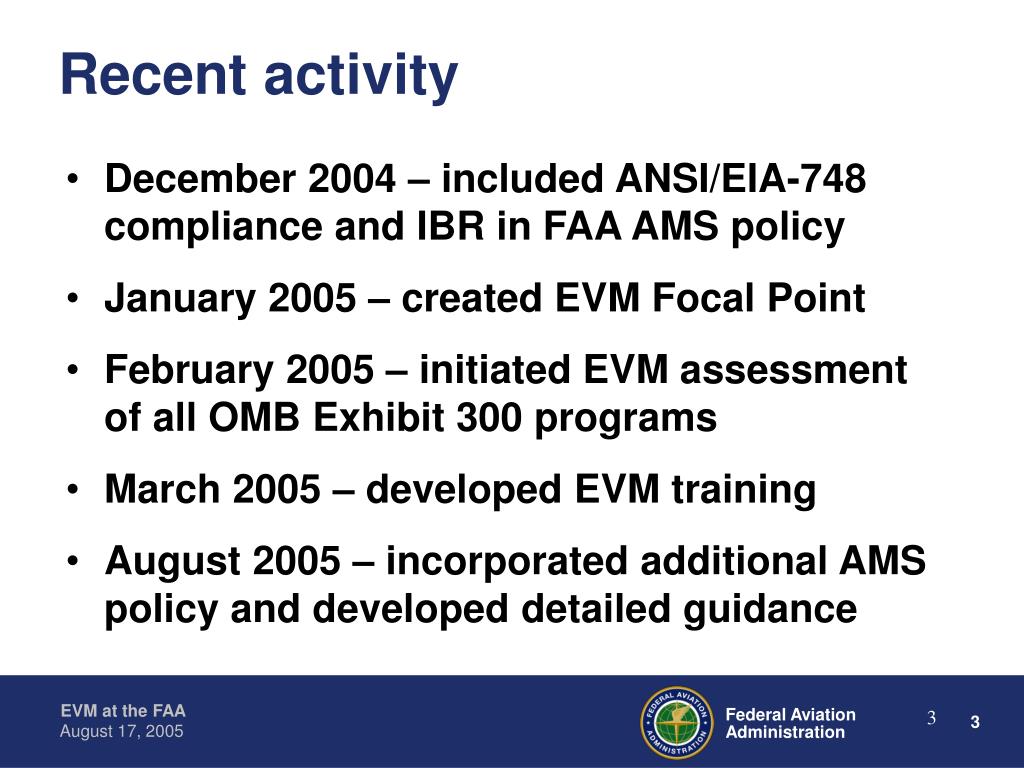

  3. Recent activity • December 2004 – included ANSI/EIA-748 compliance and IBR in FAA AMS policy • January 2005 – created EVM Focal Point • February 2005 – initiated EVM assessment of all OMB Exhibit 300 programs • March 2005 – developed EVM training • August 2005 – incorporated additional AMS policy and developed detailed guidance

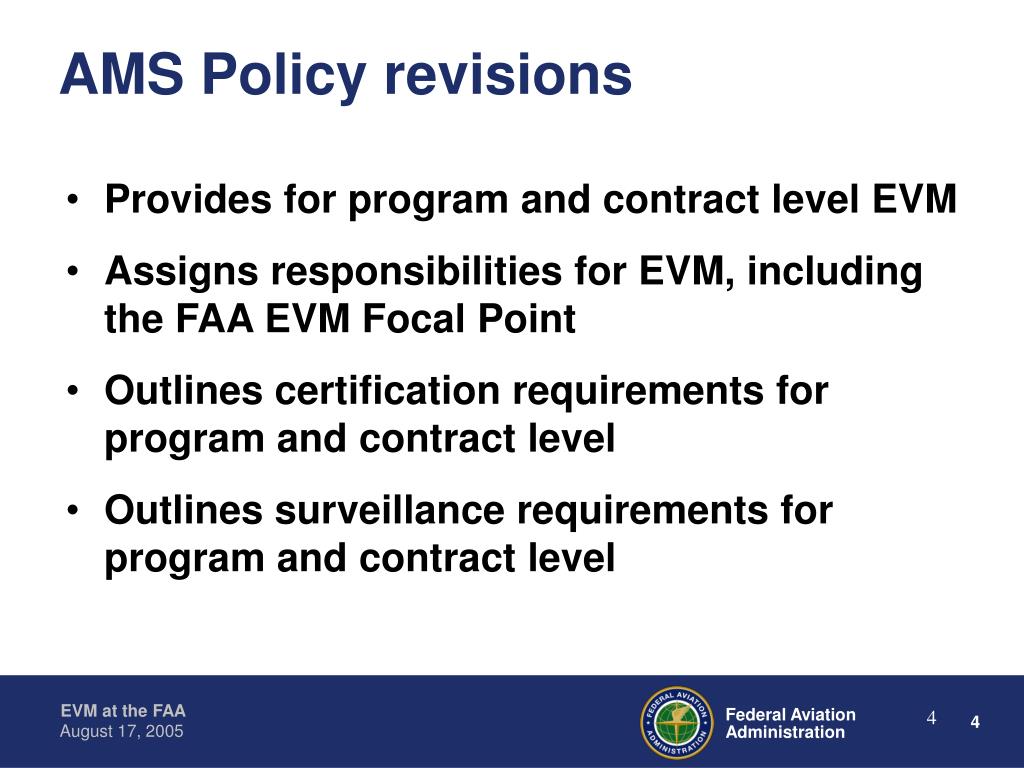

  4. AMS Policy revisions • Provides for program and contract level EVM • Assigns responsibilities for EVM, including the FAA EVM Focal Point • Outlines certification requirements for program and contract level • Outlines surveillance requirements for program and contract level

  5. EVM assessments • Programs fall into one of 5 EVM improvement categories • Planning • Programs with >2 years remaining in development/ implementation/ deployment • Programs with <2 years remaining in development/ implementation/ deployment • Programs with performing Implementations only • Full O&M/Steady State or dropped off the list • Effective sustained EVM requires a complete program management system architecture (estimating through scheduling & EVM analysis up to portfolio management) • Most program level EVM remedies lie in the project management and integrated project management domains – tie together related and supporting PM disciplines through the formation and work of a Cross-functional EVM Working Group

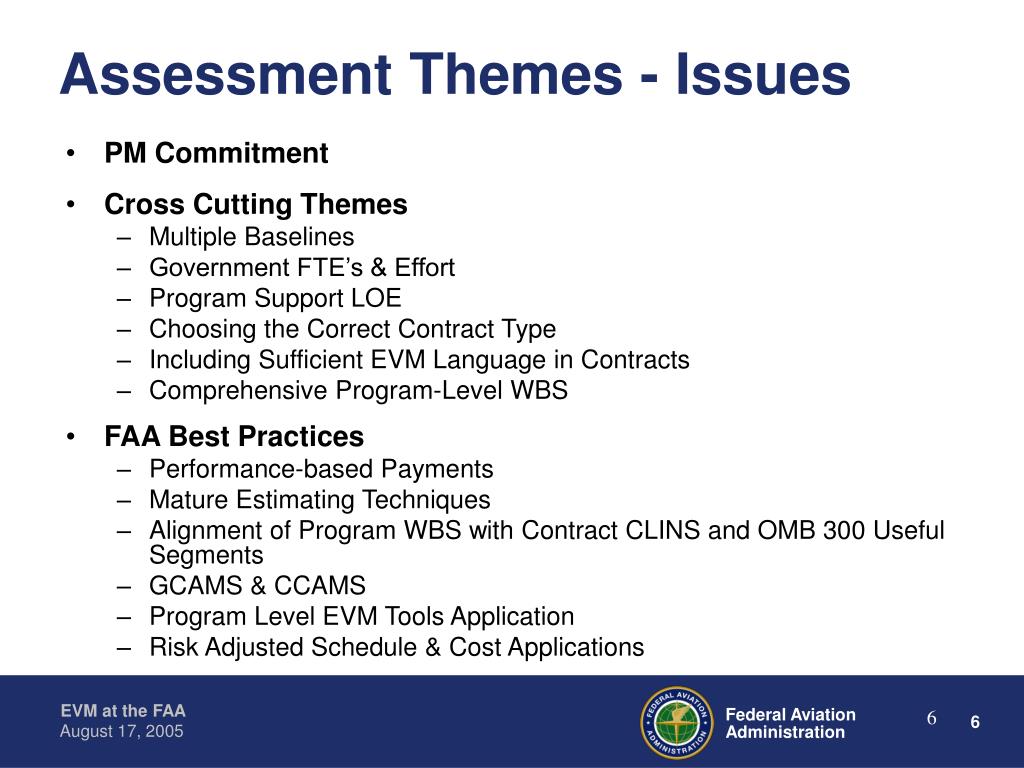

  6. Assessment Themes - Issues • PM Commitment • Cross Cutting Themes • Multiple Baselines • Government FTE’s & Effort • Program Support LOE • Choosing the Correct Contract Type • Including Sufficient EVM Language in Contracts • Comprehensive Program-Level WBS • FAA Best Practices • Performance-based Payments • Mature Estimating Techniques • Alignment of Program WBS with Contract CLINS and OMB 300 Useful Segments • GCAMS & CCAMS • Program Level EVM Tools Application • Risk Adjusted Schedule & Cost Applications

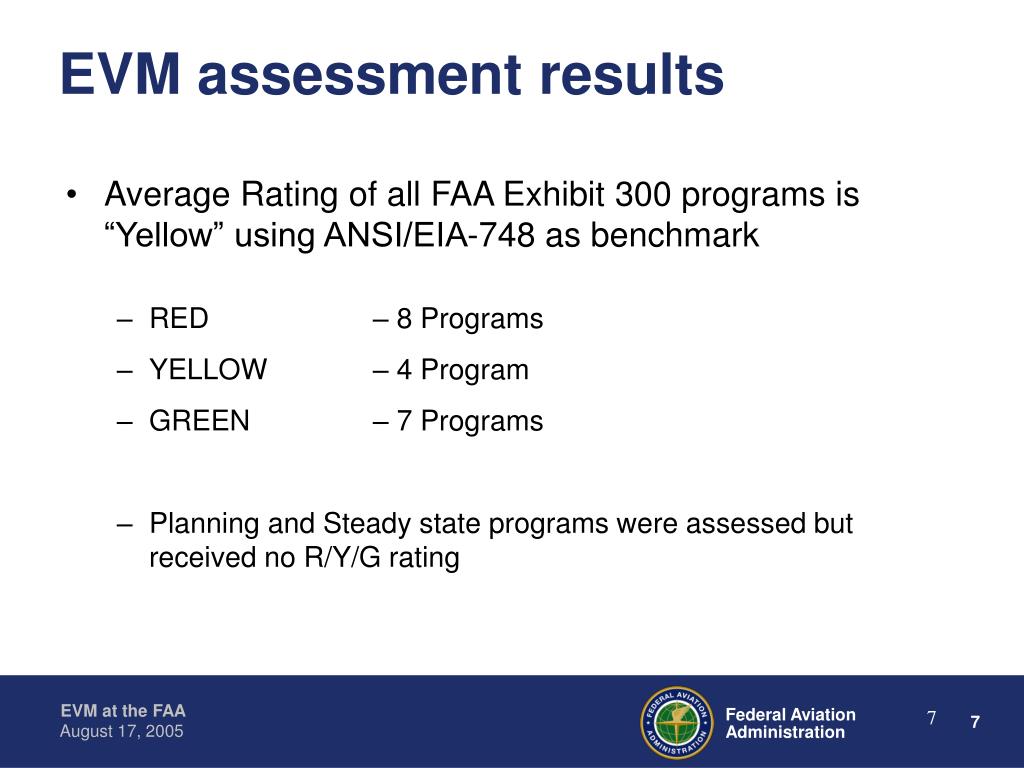

  7. EVM assessment results • Average Rating of all FAA Exhibit 300 programs is “Yellow” using ANSI/EIA-748 as benchmark • RED – 8 Programs • YELLOW – 4 Program • GREEN – 7 Programs • Planning and Steady state programs were assessed but received no R/Y/G rating

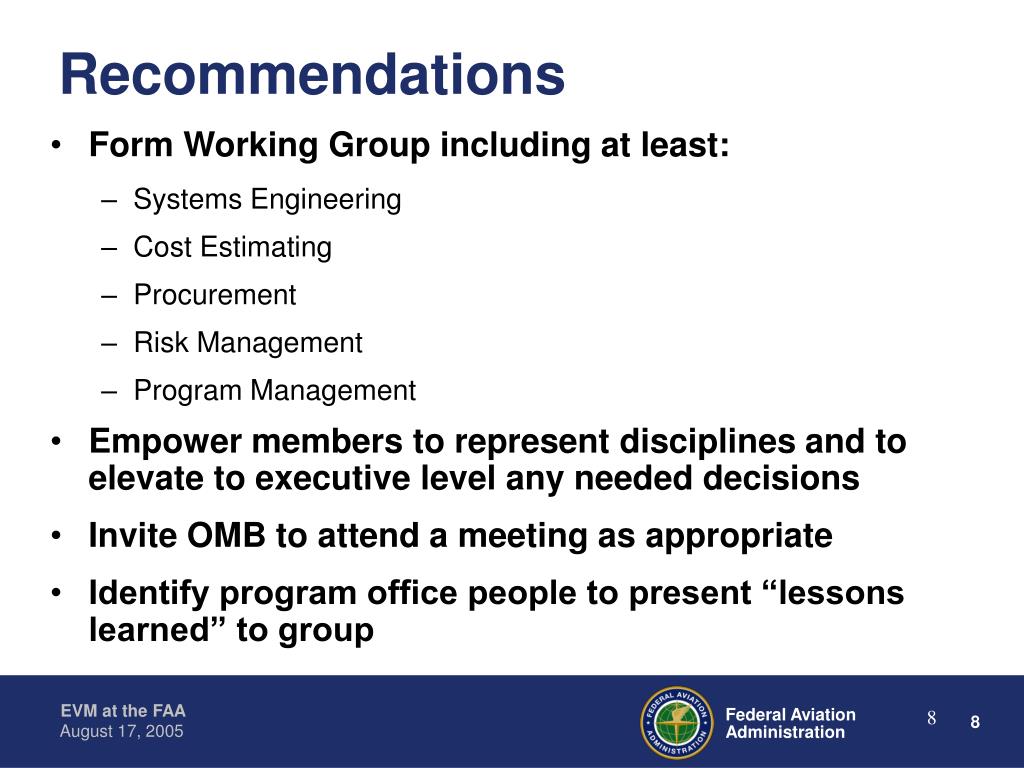

  8. Recommendations • Form Working Group including at least: • Systems Engineering • Cost Estimating • Procurement • Risk Management • Program Management • Empower members to represent disciplines and to elevate to executive level any needed decisions • Invite OMB to attend a meeting as appropriate • Identify program office people to present “lessons learned” to group

  9. Assistance Needed • Most of our contracts are with the same companies that DoD deals with • Some of the non-DoD divisions do not appear to have the EVM expertise that the DoD divisions have • We need your help to ensure a standard EVM capability and expertise within your companies, both DoD and non-DoD applications
