100 likes | 303 Views
AMIT Update to RMS. May 16, 2012 Andrea O’Flaherty SMT Project Manager. Overview & Contents. Schedule Update Large Volume Ad Hoc Usage API Request Third Party. Schedule Update. AMIT Monthly Stakeholder Steering Committee Meeting for May is canceled
E N D
AMIT Update to RMS May 16, 2012 Andrea O’Flaherty SMT Project Manager
Overview & Contents • Schedule Update • Large Volume Ad Hoc Usage API Request • Third Party AMIT Update to RMS - May 2012
Schedule Update • AMIT Monthly Stakeholder Steering Committee Meeting for May is canceled • Monthly Stakeholder Steering Committee Meetings will be held following RMS Lunch Break – Beginning in June • Schedule is updated and is found online at: http://www.puc.state.tx.us/industry/projects/electric/34610/34610.aspx AMIT Update to RMS - May 2012
Large Volume Ad Hoc Usage API Request • Background • The intended use of the Adhoc APIs is to retrieve the usage data from SMT for a specific set of ESIIDs for certain duration. This data is provided in CSV format. • The vehicle for building history is the LSE usage files sent daily via FTP for all the ESIIDs belonging to each ROR. • Recently there have been multiple requests to backfill the entire historical data for all the ESIIDs by a few RORs. • Large requests, using the previous API sizing, have been observed impacting system performance. • The API Usage request/call sizing has been redefined and is documented in the API guide AMIT Update to RMS - May 2012

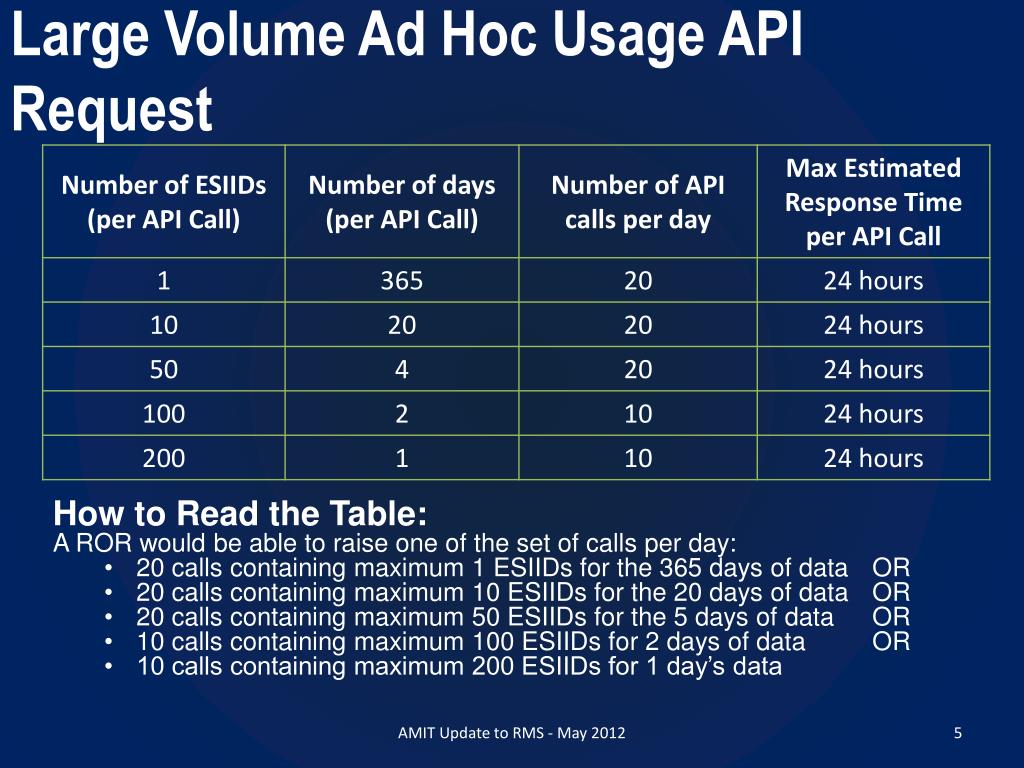

Large Volume Ad Hoc Usage API Request • How to Read the Table: • A ROR would be able to raise one of the set of calls per day: • 20 calls containing maximum 1 ESIIDs for the 365 days of data OR • 20 calls containing maximum 10 ESIIDs for the 20 days of data OR • 20 calls containing maximum 50 ESIIDs for the 5 days of data OR • 10 calls containing maximum 100 ESIIDs for 2 days of data OR • 10 calls containing maximum 200 ESIIDs for 1 day’s data AMIT Update to RMS - May 2012

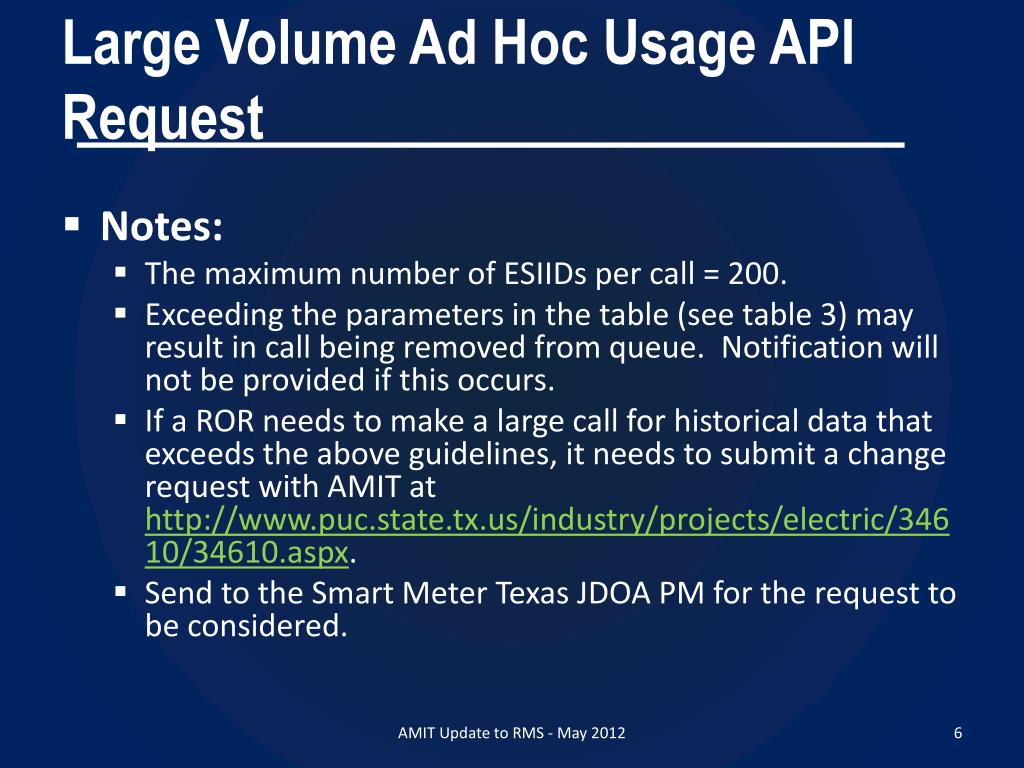

Large Volume Ad Hoc Usage API Request • Notes: • The maximum number of ESIIDs per call = 200. • Exceeding the parameters in the table (see table 3) may result in call being removed from queue. Notification will not be provided if this occurs. • If a ROR needs to make a large call for historical data that exceeds the above guidelines, it needs to submit a change request with AMIT at http://www.puc.state.tx.us/industry/projects/electric/34610/34610.aspx. • Send to the Smart Meter Texas JDOA PM for the request to be considered. AMIT Update to RMS - May 2012

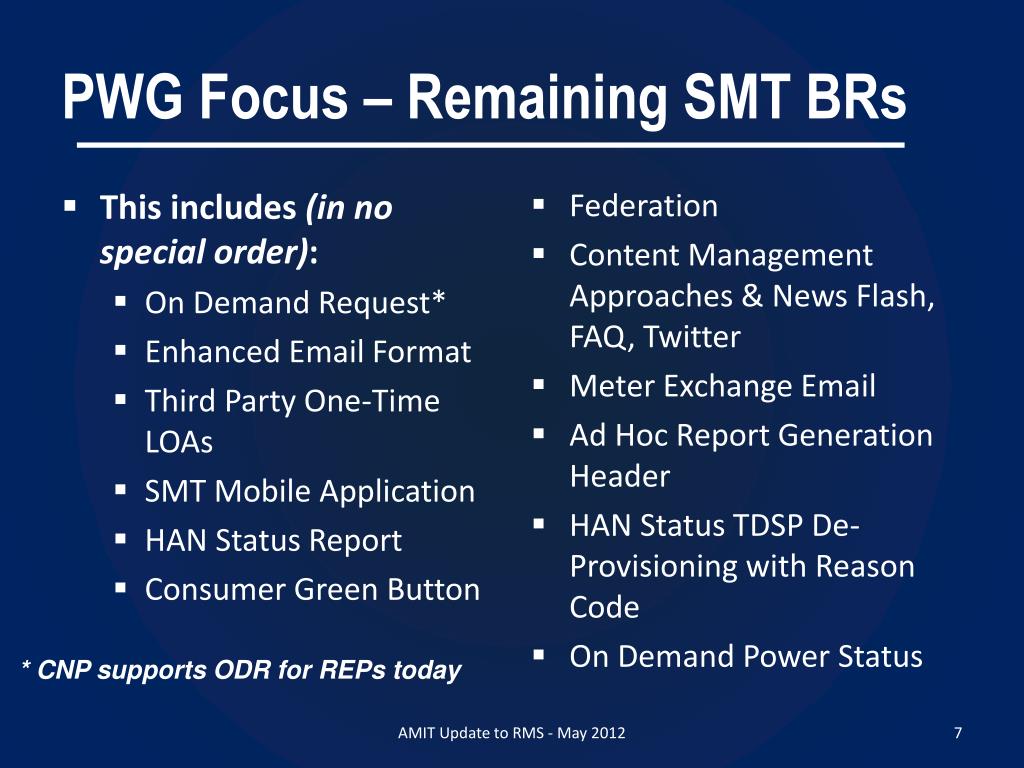

PWG Focus – Remaining SMT BRs • This includes (in no special order): • On Demand Request* • Enhanced Email Format • Third Party One-Time LOAs • SMT Mobile Application • HAN Status Report • Consumer Green Button • Federation • Content Management Approaches & News Flash, FAQ, Twitter • Meter Exchange Email • Ad Hoc Report Generation Header • HAN Status TDSP De-Provisioning with Reason Code • On Demand Power Status * CNP supports ODR for REPs today AMIT Update to RMS - May 2012

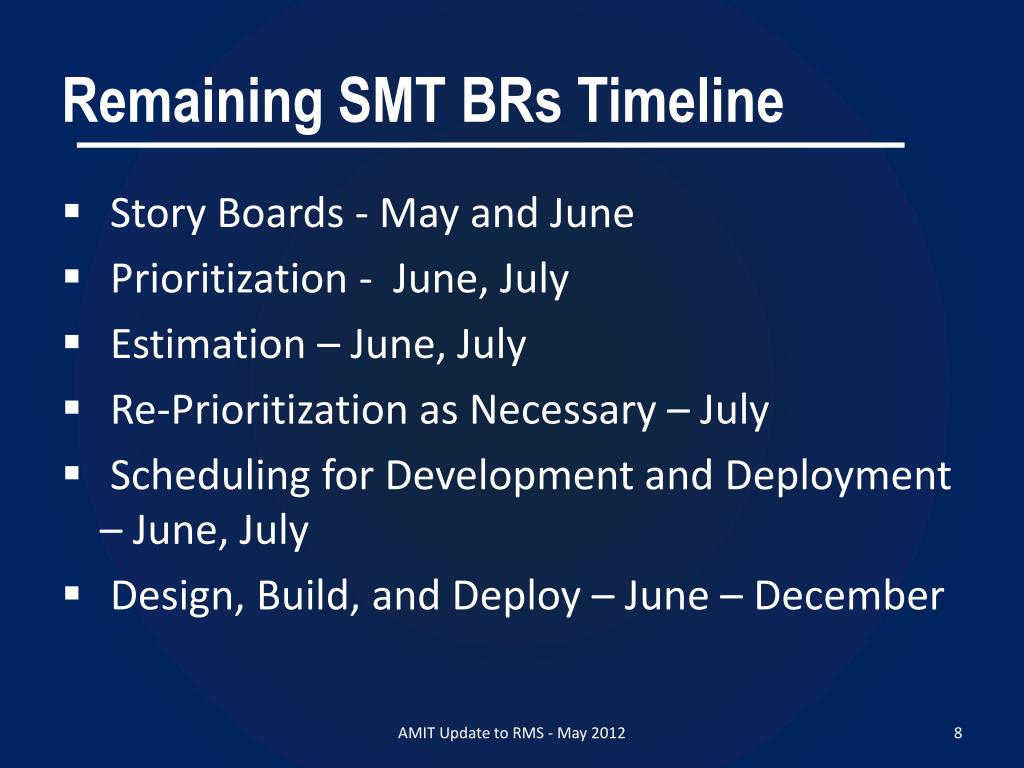

Remaining SMT BRs Timeline • Story Boards - May and June • Prioritization - June, July • Estimation – June, July • Re-Prioritization as Necessary – July • Scheduling for Development and Deployment – June, July • Design, Build, and Deploy – June – December AMIT Update to RMS - May 2012
Projects Working Group • Holding Web Ex Meetings every Friday from 9-11:00 am • Purpose of the meetings is to work through BRs and Storyboards – finalize, send to Stakeholder Steering for approval • Will be holding a one-day special Third Party Workshop on May 22, 2012 @ ERCOT AMIT Update to RMS - May 2012
? AMIT Update to RMS - May 2012
