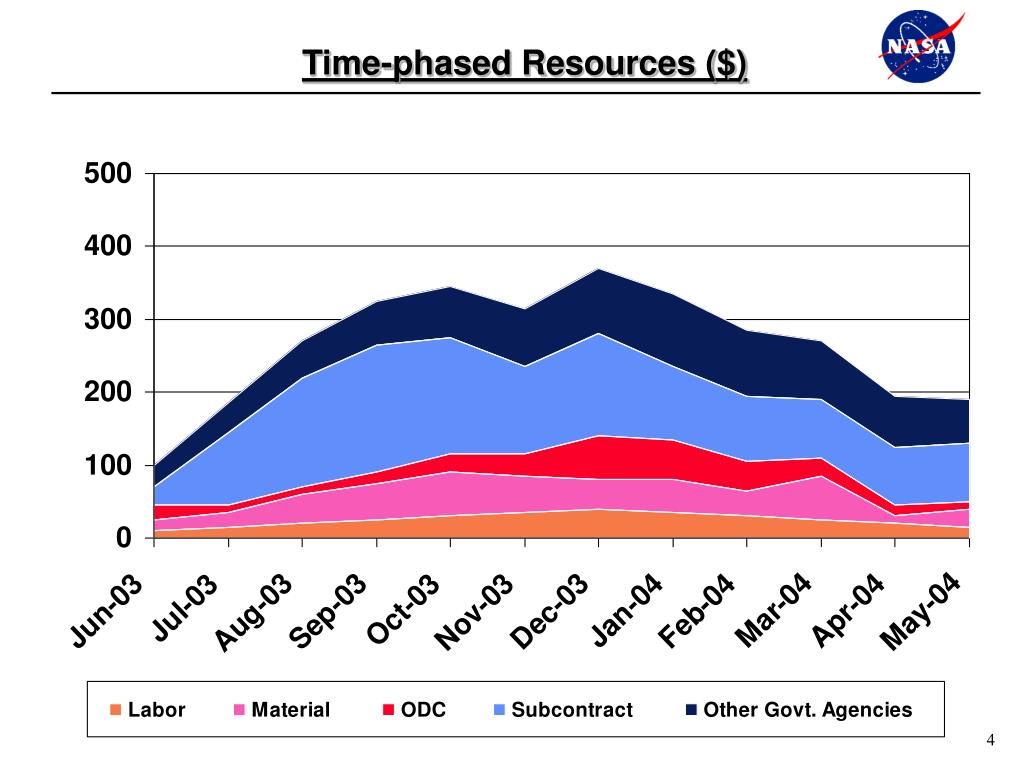

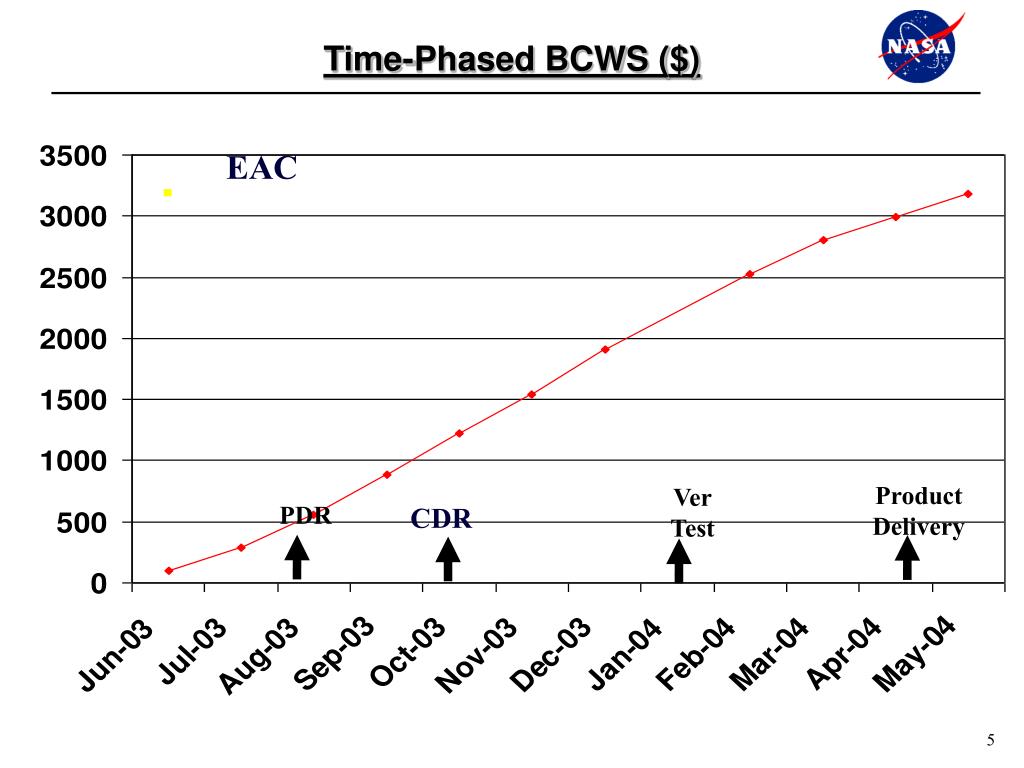

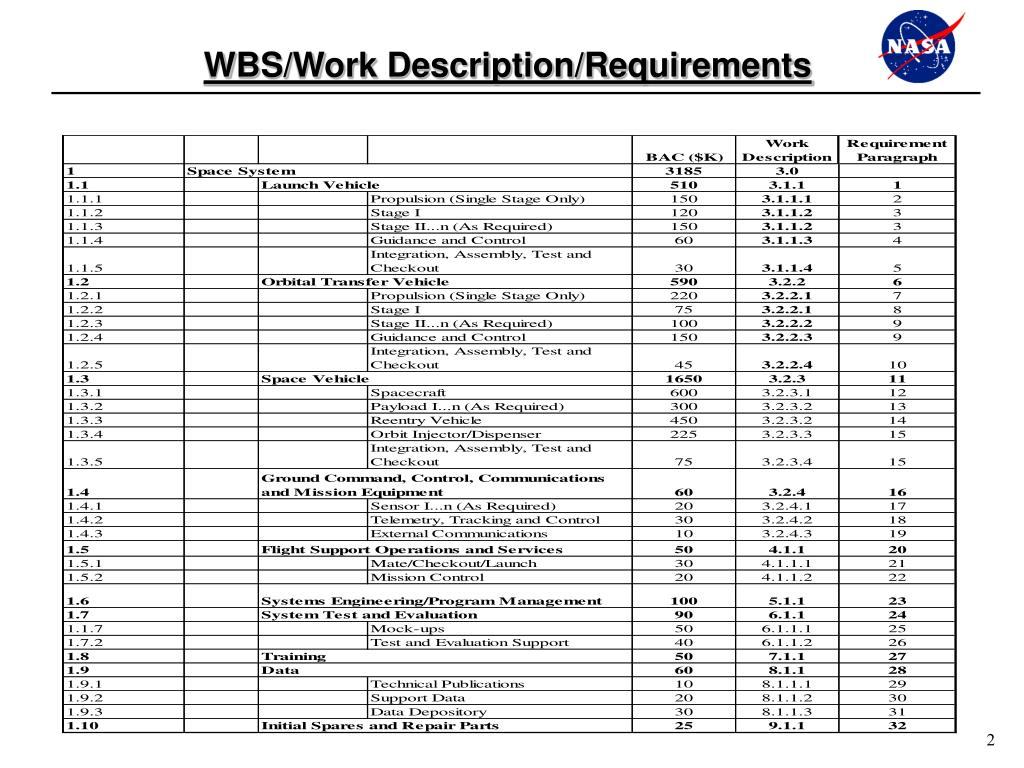

Integrated Baseline Review (IBR) Project Name. Project Manager’s Name Date. WBS/Work Description/Requirements. Basis Of Estimate (BOE). Time-phased Resources ($). Product Delivery. Ver Test. PDR. CDR. Time-Phased BCWS ($). EAC. Schedule. Work/Planning Package Summary.
E N D
Integrated Baseline Review (IBR)Project Name Project Manager’s Name Date
Product Delivery Ver Test PDR CDR Time-Phased BCWS ($) EAC

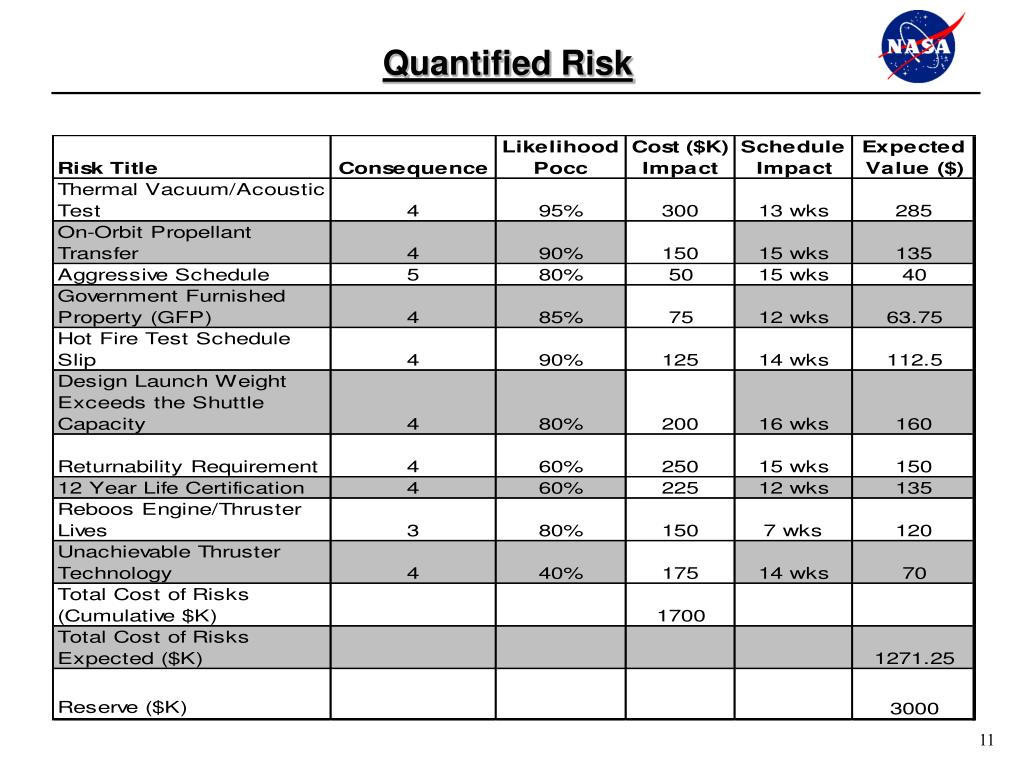

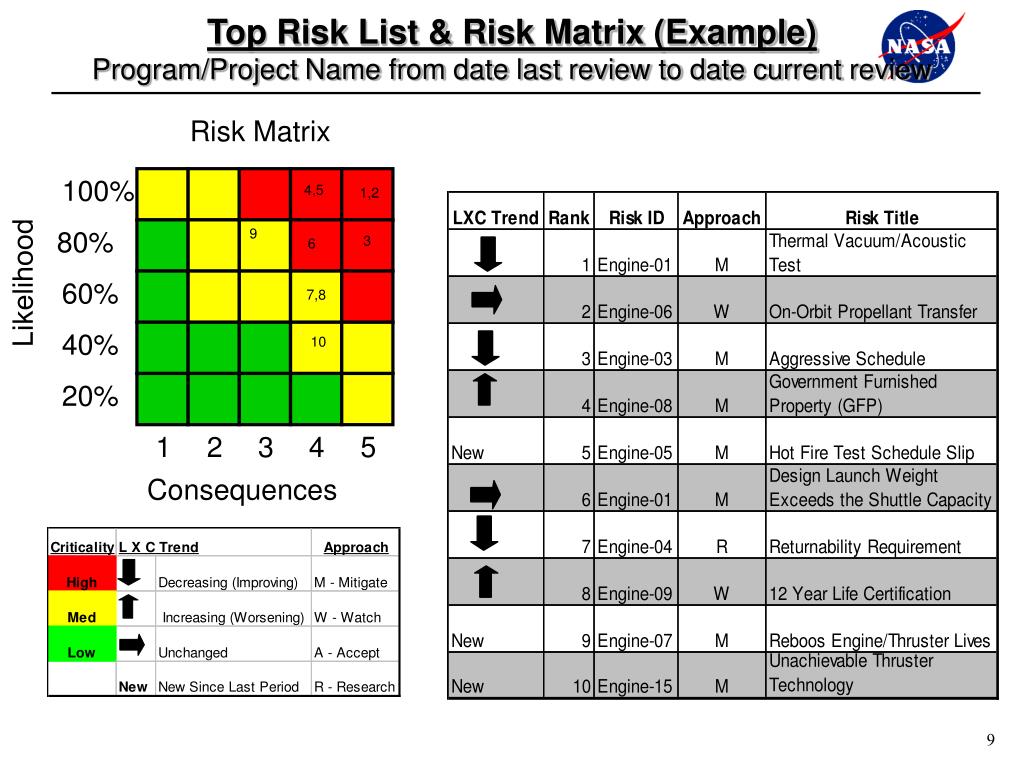

Risk Matrix 100% 4,5 1,2 80% 9 3 6 Likelihood 60% 7,8 40% 10 4 20% 1 2 3 5 Consequences Top Risk List & Risk Matrix (Example)Program/Project Name from date last review to date current review

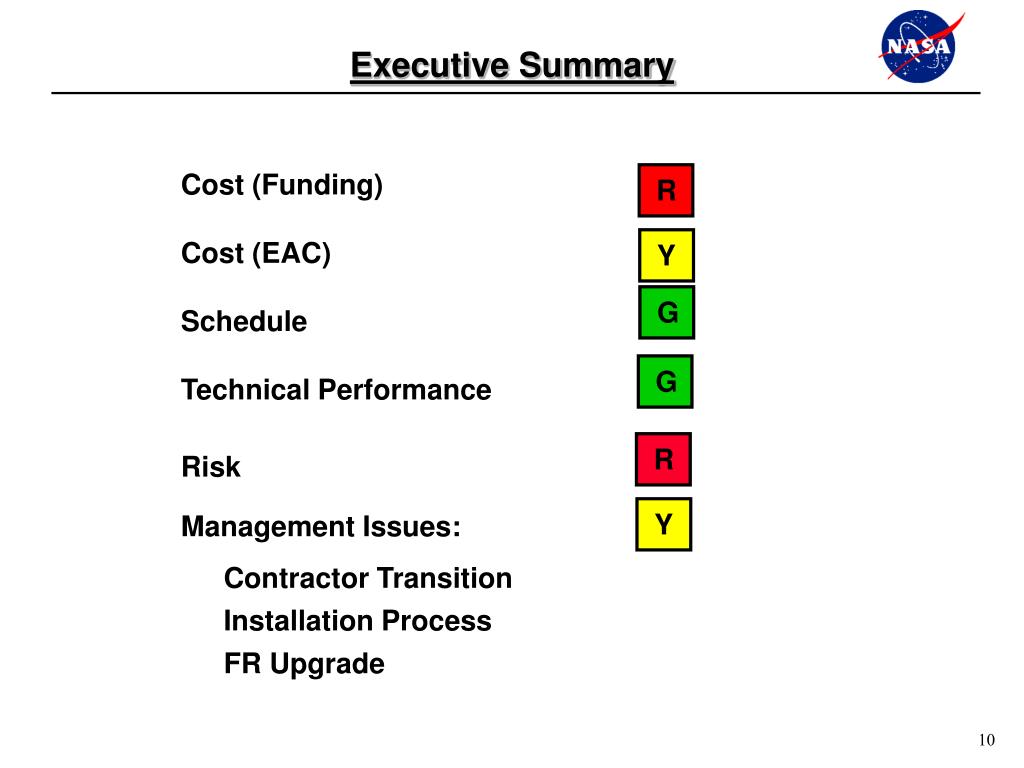

R Y G G R Y Executive Summary Cost (Funding) Cost (EAC) Schedule Technical Performance Risk Management Issues: Contractor Transition Installation Process FR Upgrade
