An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Apex Information Systems Anuja Jahagirdar Jason Miller Amol Kakade Priyanka Akella Bhaumik Shah Project Planning

  2. Project • Title: Medical Insurance Management System • Start Date: 07 Feb,2011 • Finish Date: 25 April,2011 • Manager: AnujaJahagirdar.

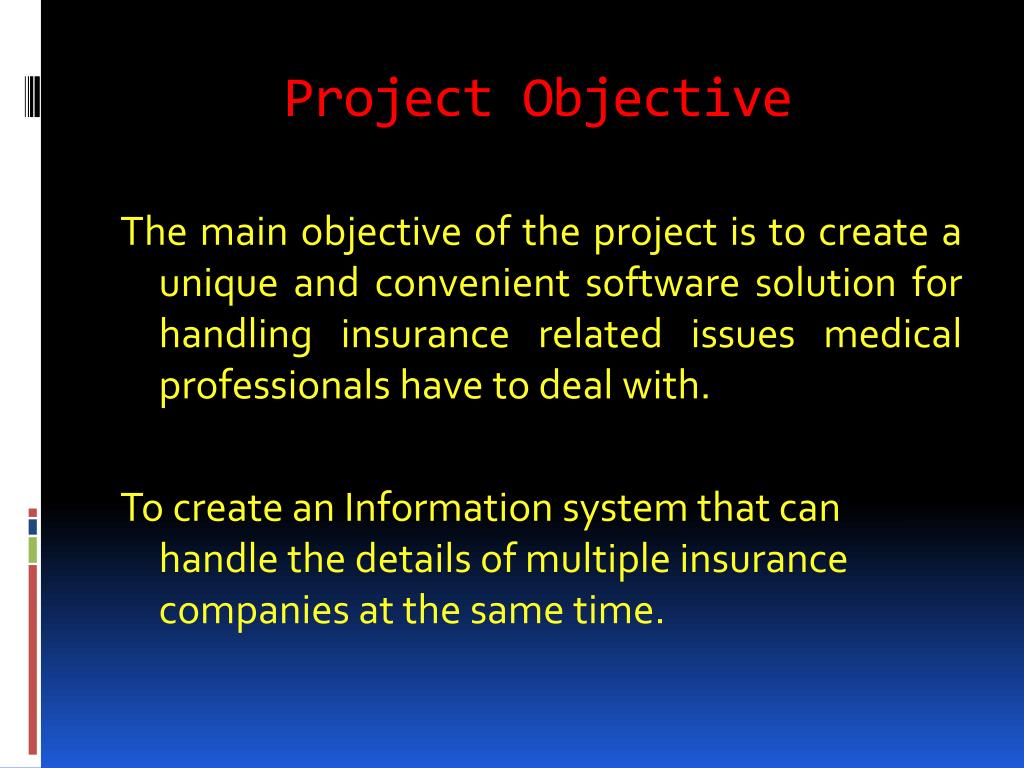

  3. Project Objective The main objective of the project is to create a unique and convenient software solution for handling insurance related issues medical professionals have to deal with. To create an Information system that can handle the details of multiple insurance companies at the same time.

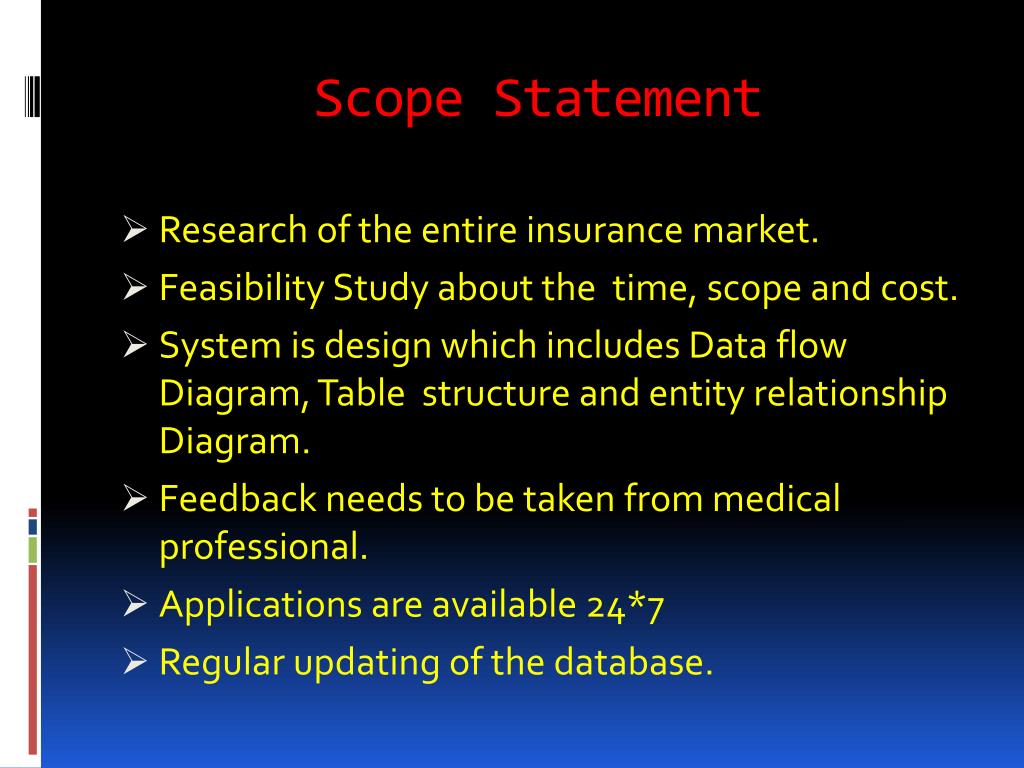

  4. Scope Statement • Research of the entire insurance market. • Feasibility Study about the time, scope and cost. • System is design which includes Data flow Diagram, Table structure and entity relationship Diagram. • Feedback needs to be taken from medical professional. • Applications are available 24*7 • Regular updating of the database.

  5. Scope Statement Contd. • Project Success Criteria: The goal is to complete the project within 12 weeks for budget no more than $200,000. The project sponsor, Dr. Rob Mohammad, has emphasized the needs and details which are to be taken care of. To meet this goal, it is crucial to identify the bottle-neck in the operation processing, then analyze the code and check the product. These two methods will save processing times and also save resources and times. If the project takes a little longer time to complete and a little higher cost than what we have planned, this project still is still considered as a success project, if it allows the company to save money and times in business operations and at the same time is utilized in providing services to its customers.

  6. Work Breakdown Structure • Initiating • Planning • Executing • Controlling • Closing

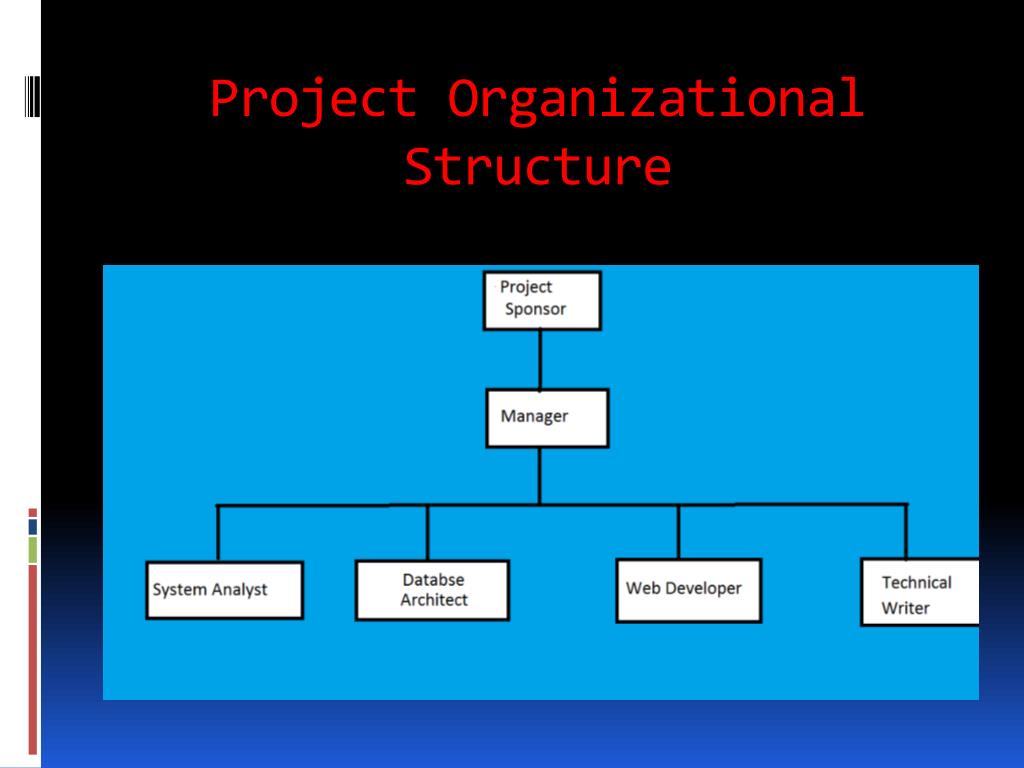

  7. Project Organizational Structure

  8. Responsibility Assignment Matrix

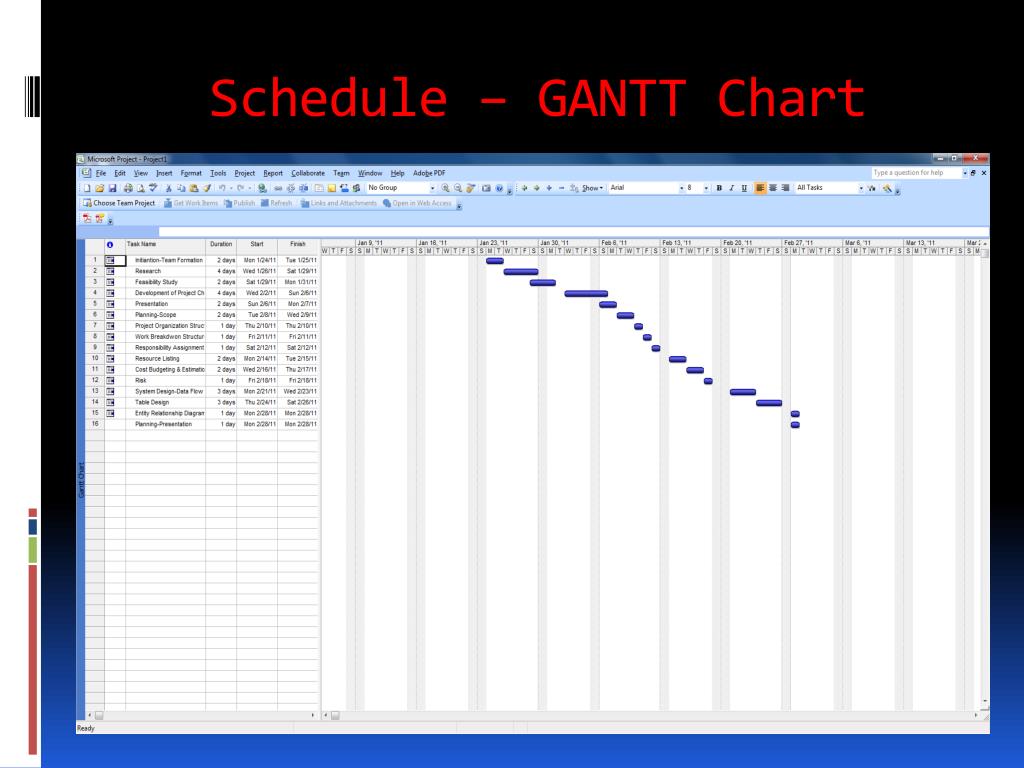

  9. Schedule – GANTT Chart

  10. Resource Listing • Hardware: • 5 Dell workstations • 1 HP all-in-one printer • Software: • Microsoft Office Suite • Microsoft Project • Microsoft Visio • Adobe Creative Suite • Microsoft Visual Studio 2011

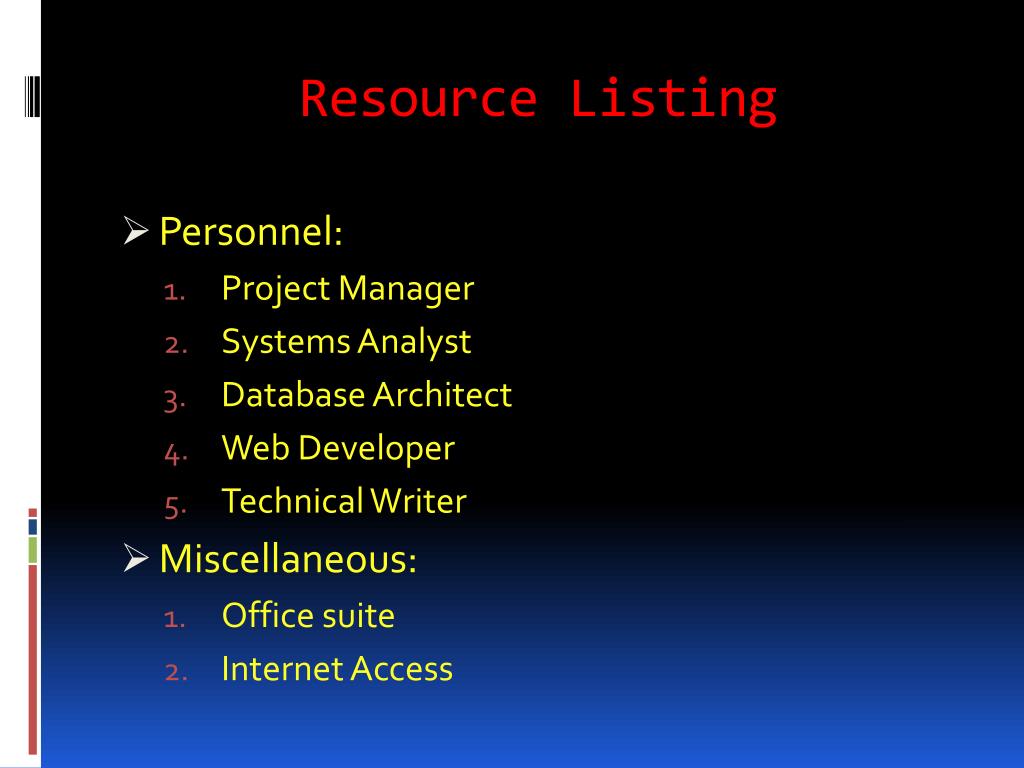

  11. Resource Listing • Personnel: • Project Manager • Systems Analyst • Database Architect • Web Developer • Technical Writer • Miscellaneous: • Office suite • Internet Access

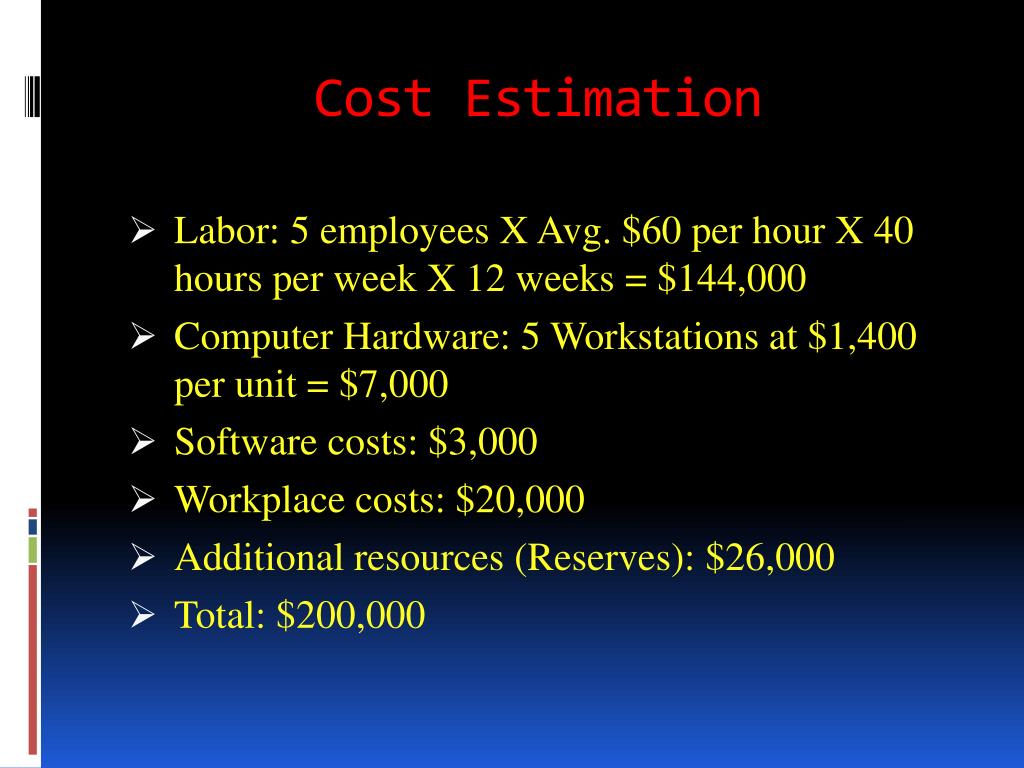

  12. Cost Estimation • Labor: 5 employees X Avg. $60 per hour X 40 hours per week X 12 weeks = $144,000 • Computer Hardware: 5 Workstations at $1,400 per unit = $7,000 • Software costs: $3,000 • Workplace costs: $20,000 • Additional resources (Reserves): $26,000 • Total: $200,000

  13. Cost Estimation

  14. Risks • Due to time constraints, getting the project done on time might be difficult • Lack of input from the stakeholders • Difficulty working with different insurance companies • Stakeholders lack experience to implement the project • Security risks dealing with patient data

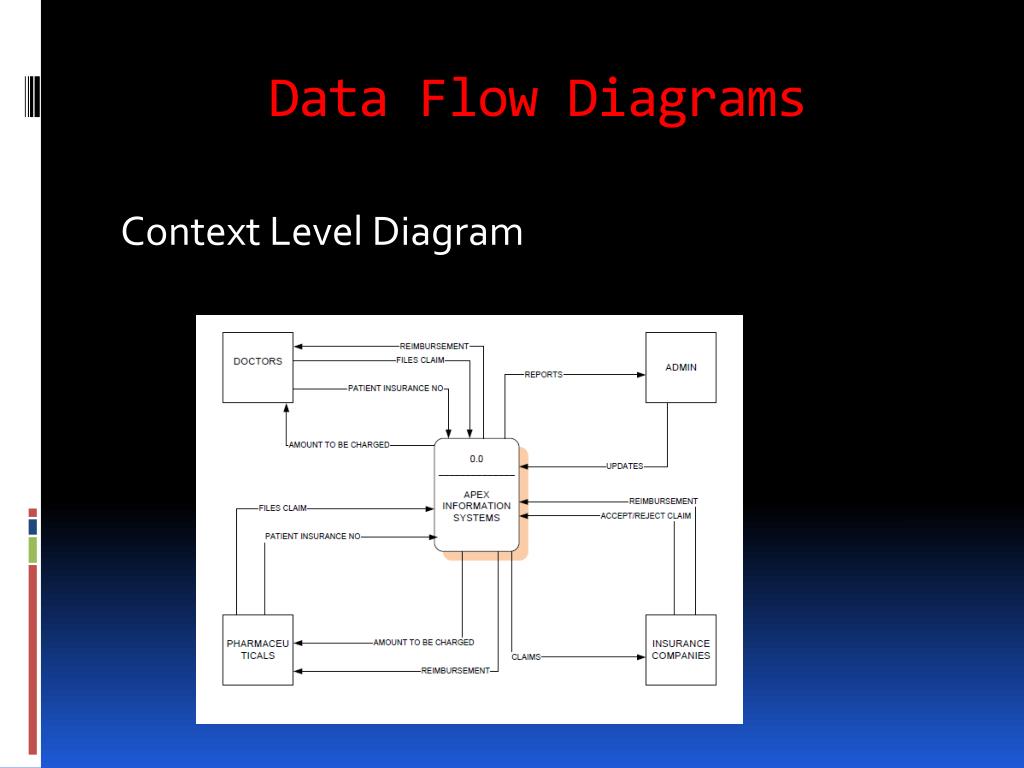

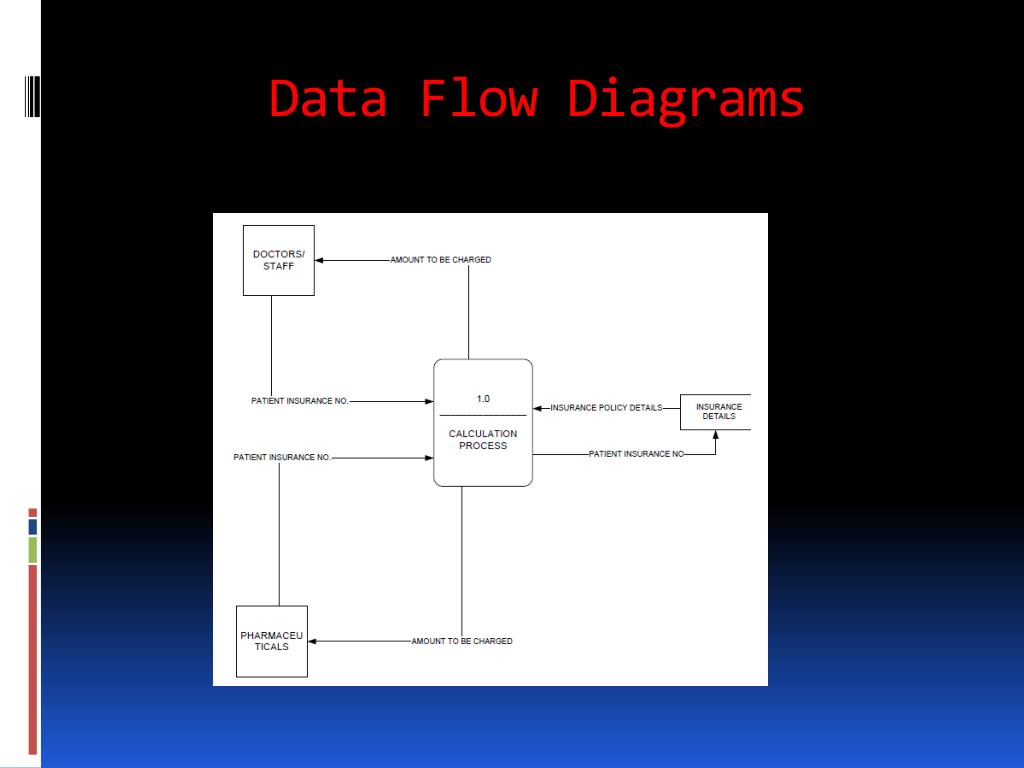

  15. Data Flow Diagrams Context Level Diagram

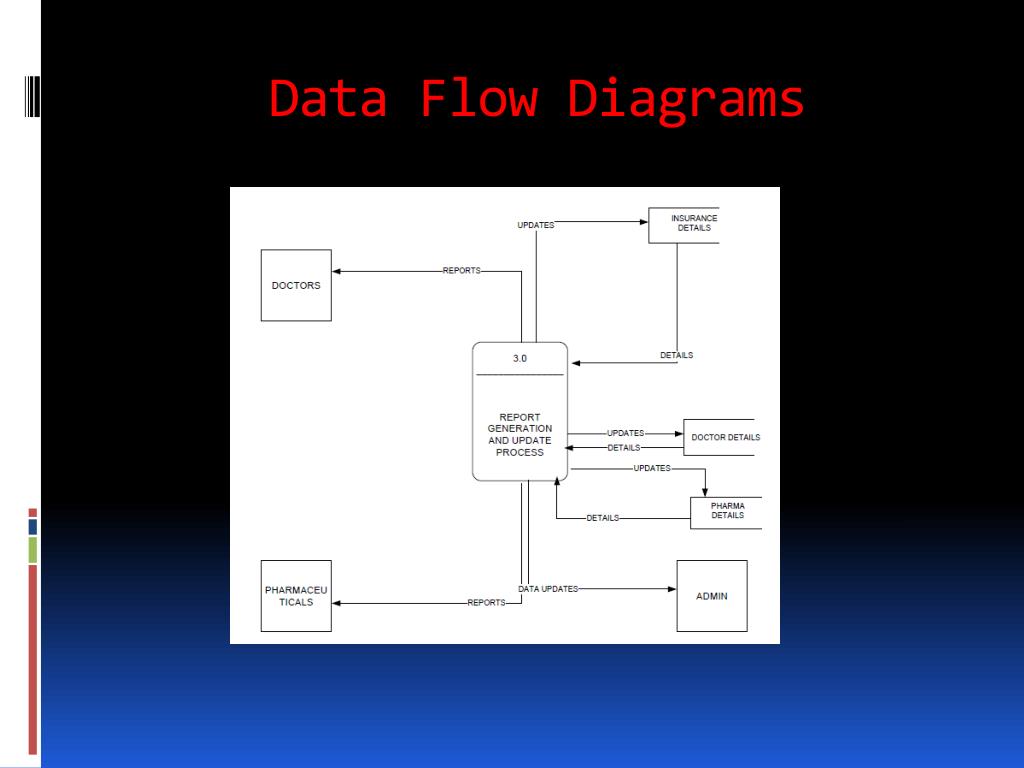

  16. Data Flow Diagrams

  17. Data Flow Diagrams

  18. Data Flow Diagrams

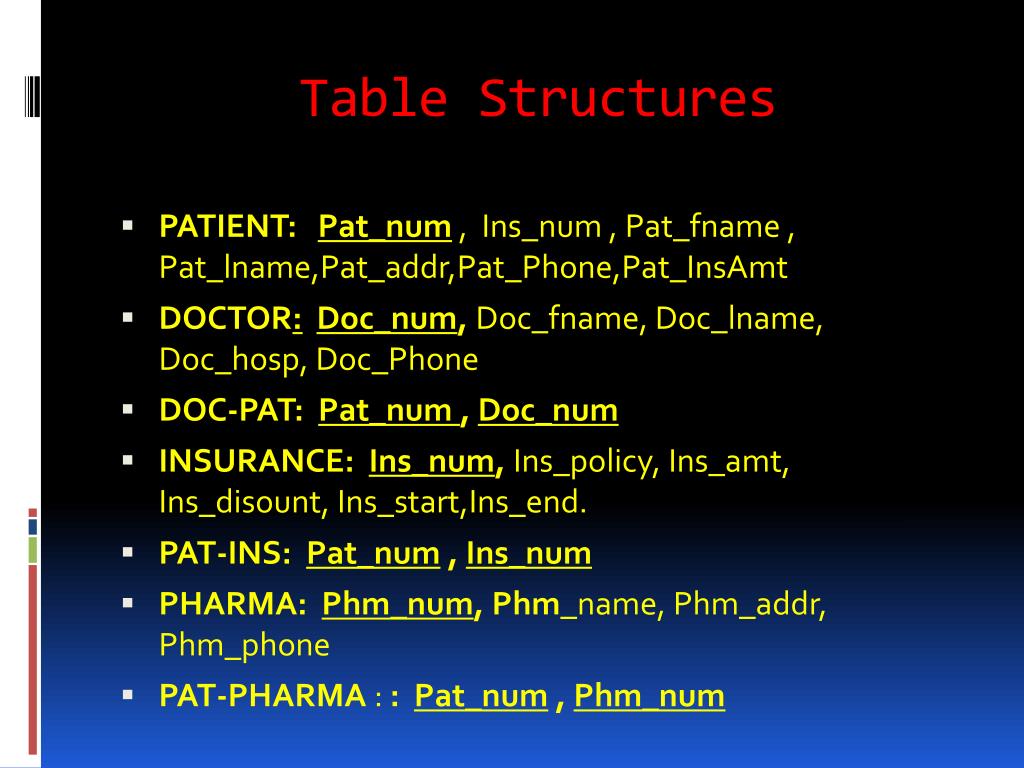

  19. Table Structures • PATIENT:Pat_num , Ins_num , Pat_fname , Pat_lname,Pat_addr,Pat_Phone,Pat_InsAmt • DOCTOR:Doc_num, Doc_fname, Doc_lname, Doc_hosp, Doc_Phone • DOC-PAT: Pat_num , Doc_num • INSURANCE: Ins_num, Ins_policy, Ins_amt, Ins_disount, Ins_start,Ins_end. • PAT-INS: Pat_num , Ins_num • PHARMA: Phm_num, Phm_name, Phm_addr, Phm_phone • PAT-PHARMA : : Pat_num , Phm_num

  20. Entity Relationship Diagram

  21. Thank you !!! & Questions…???
